Project Update
Current Progress as of September...
Project Update

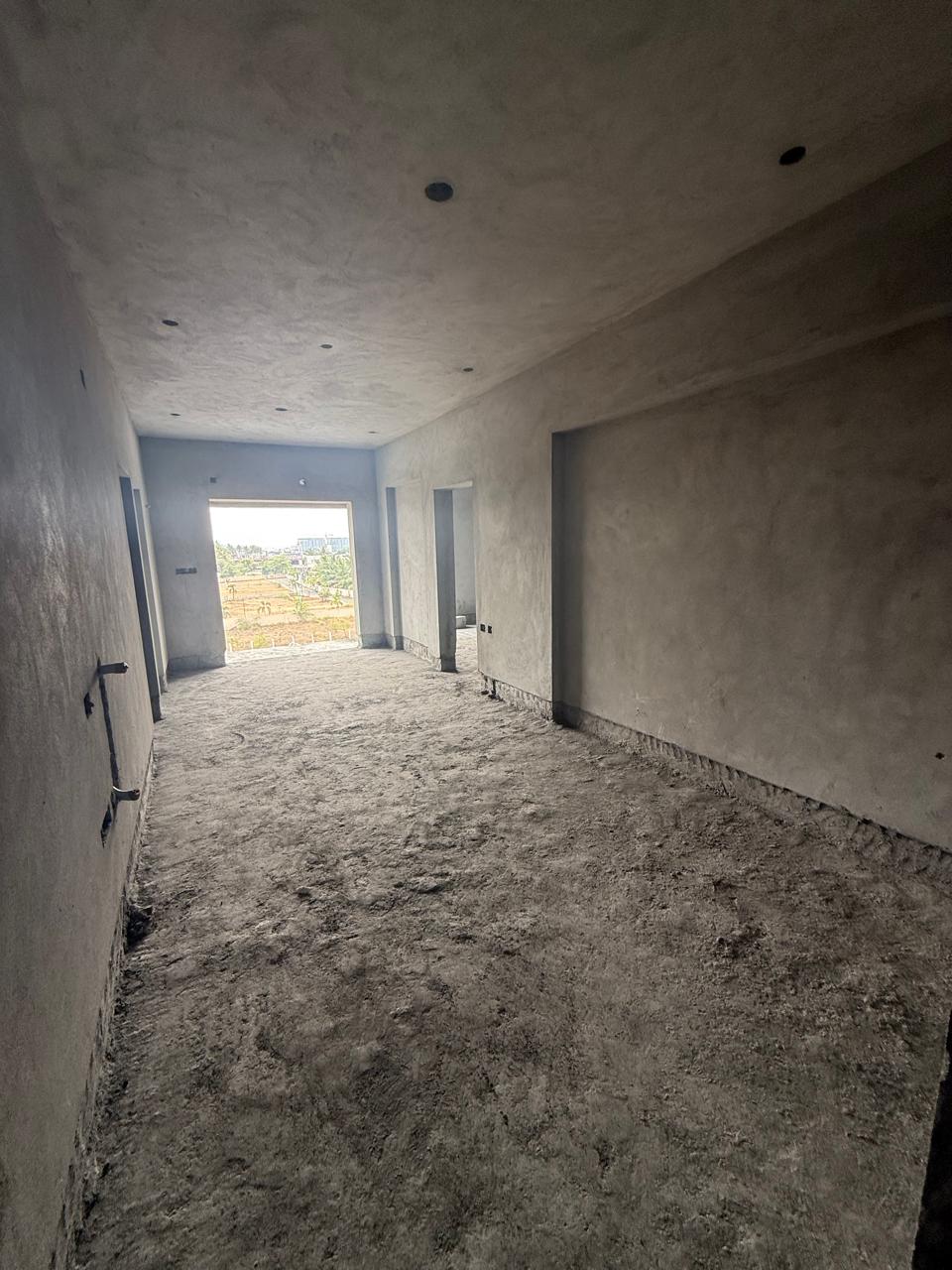

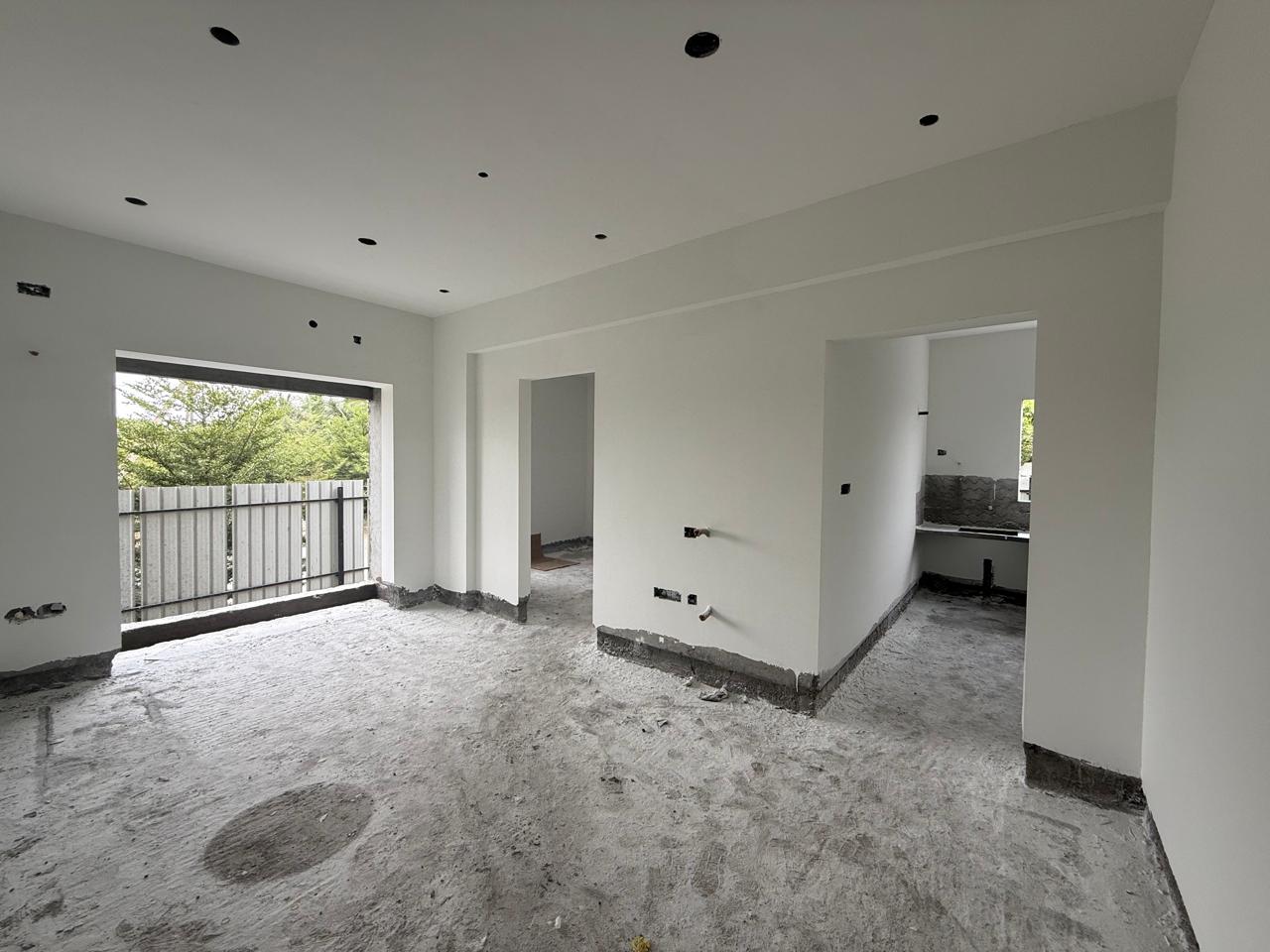

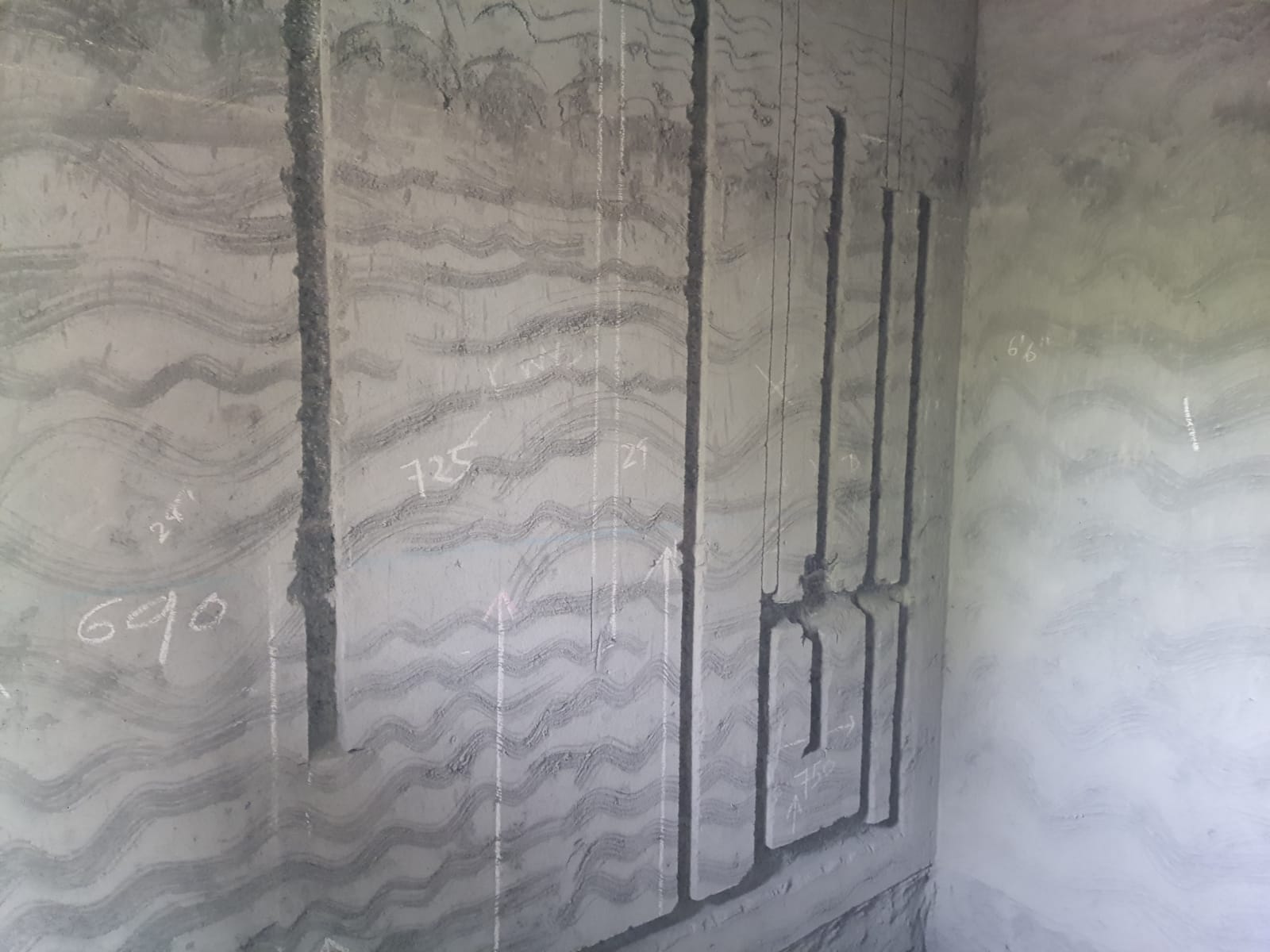

Painting work: 1st floor painting work has been started
Project Update

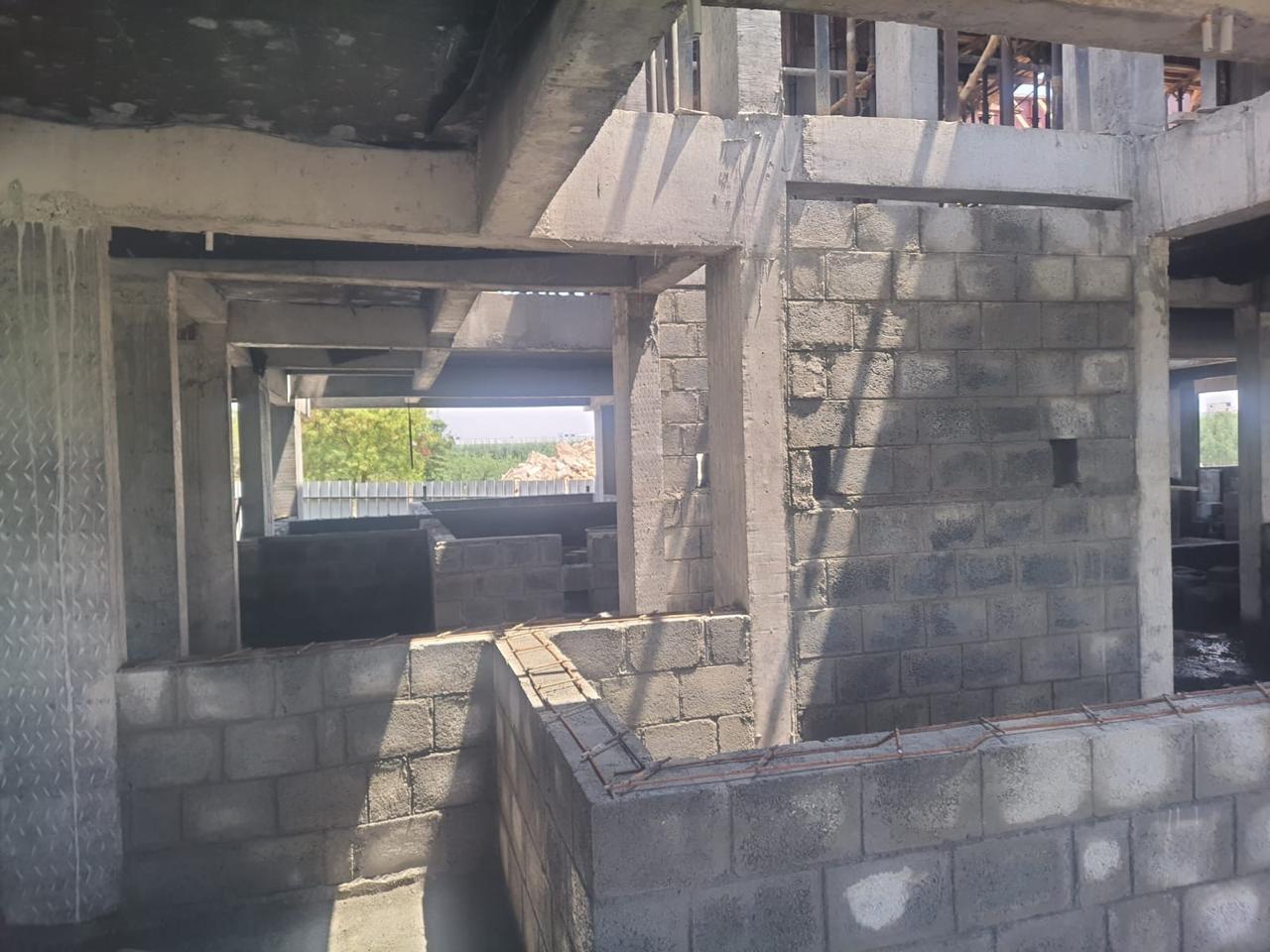

Plastering work: 5th floor inner plastering has been started
Project Update
Plumbing work: 2nd floor plumbing work has been completed
Project Update

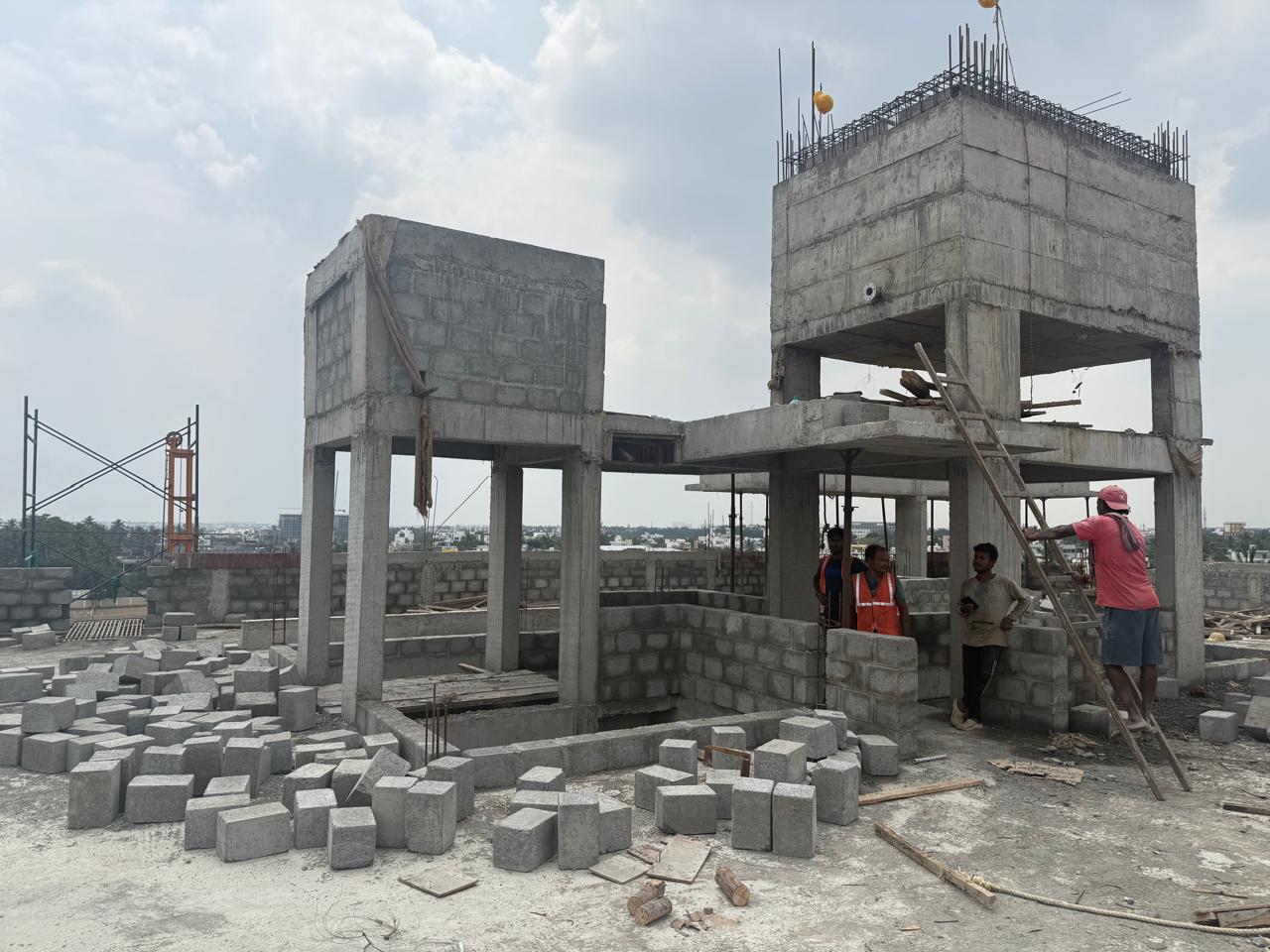

Clubhouse: 5th floor – Multipurpose Hall-block work has been completed
Project Update

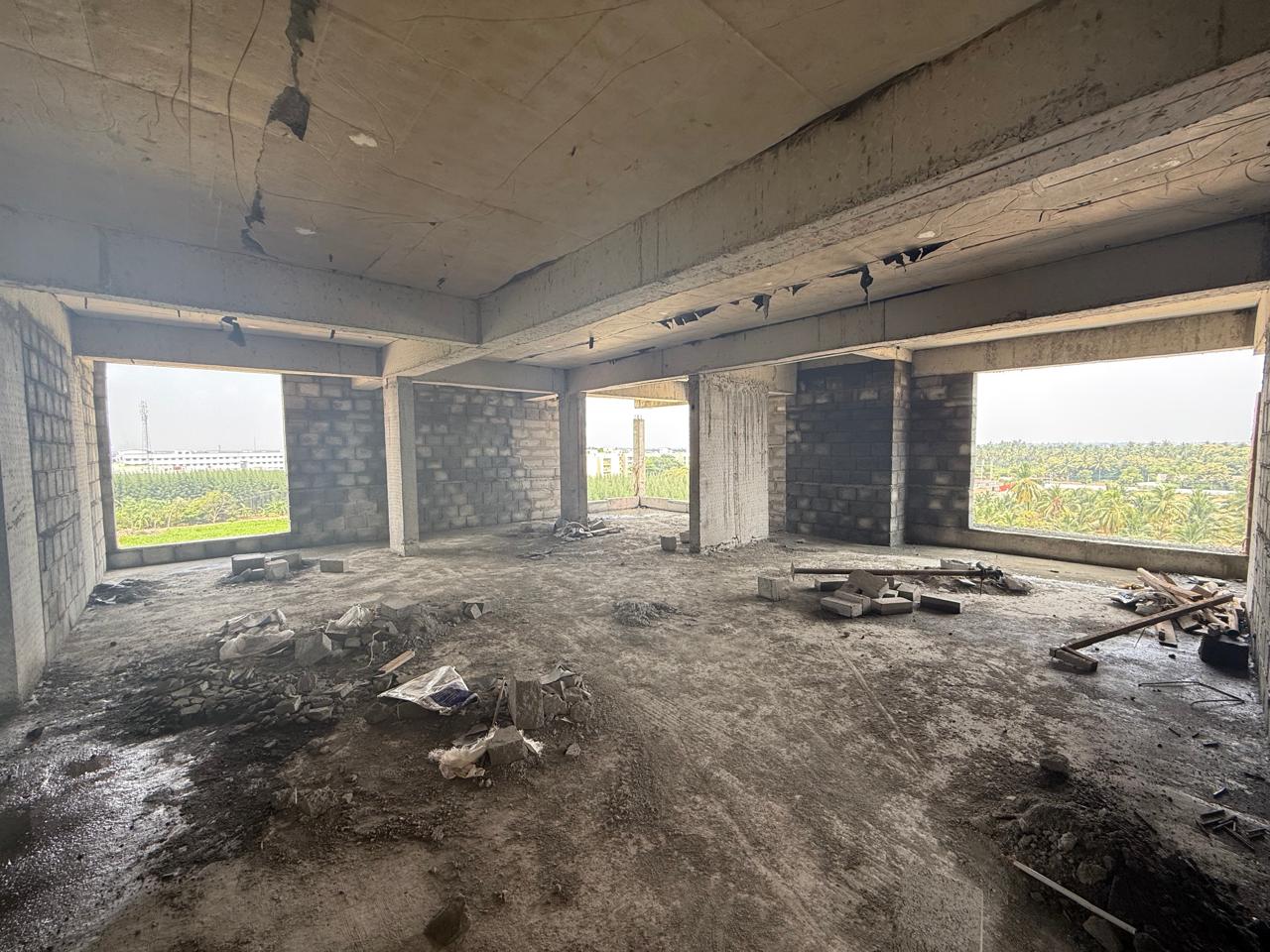

Terrace floor: Headroom and elevation have been completed. OHT work is going on.
Project Update
Your dream space is getting closer, one milestone at a time! ✨
Project Update

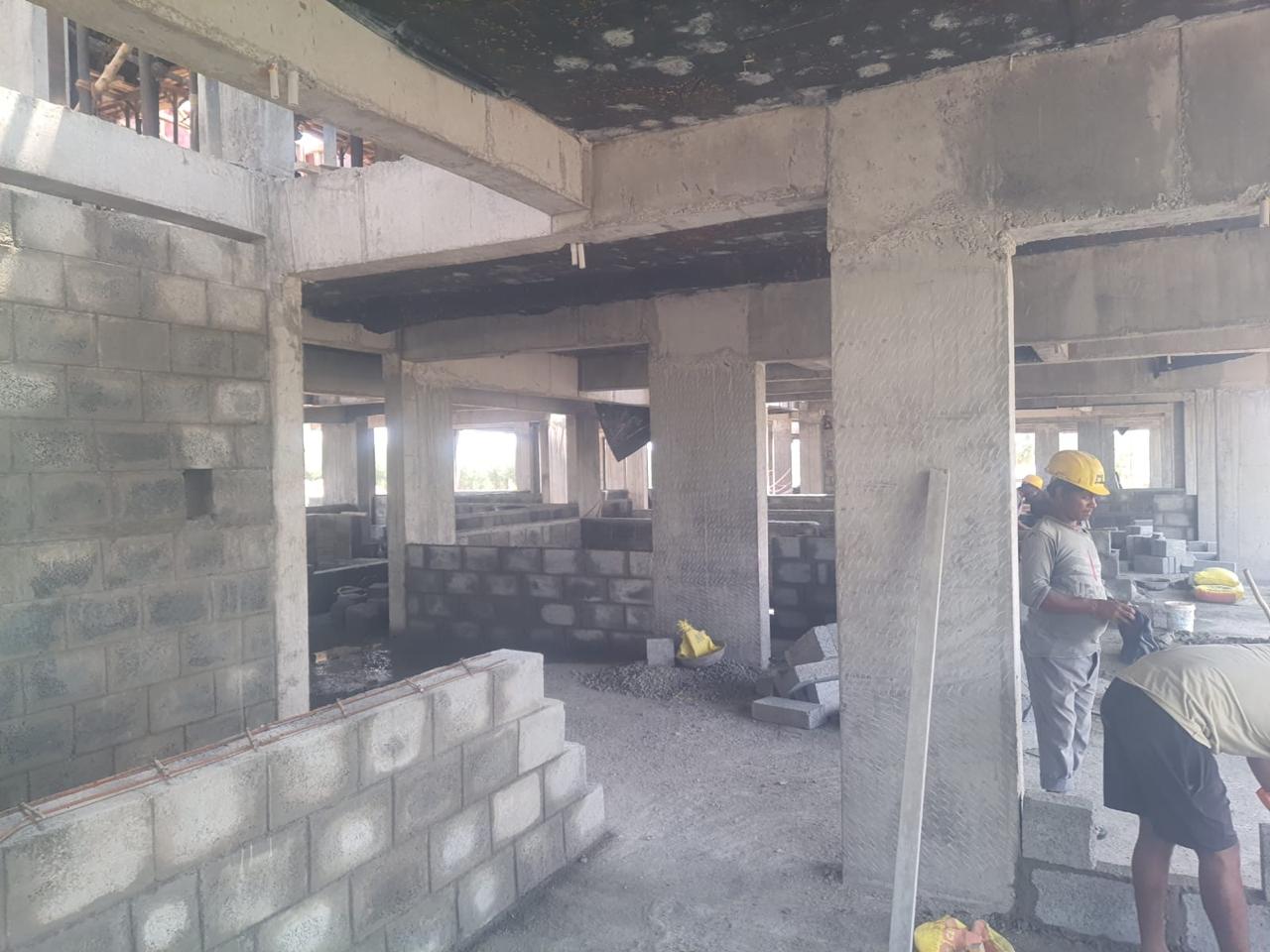

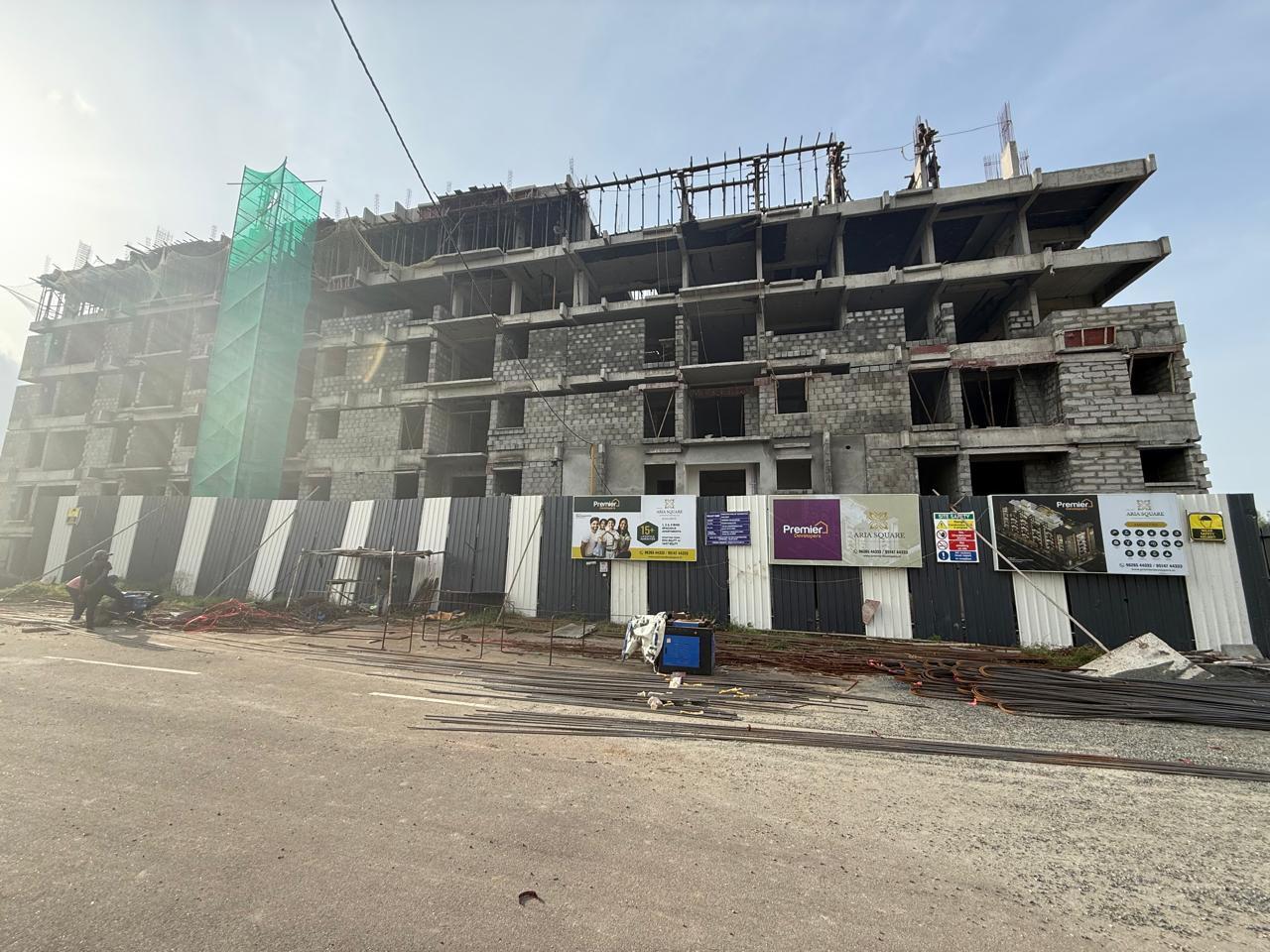

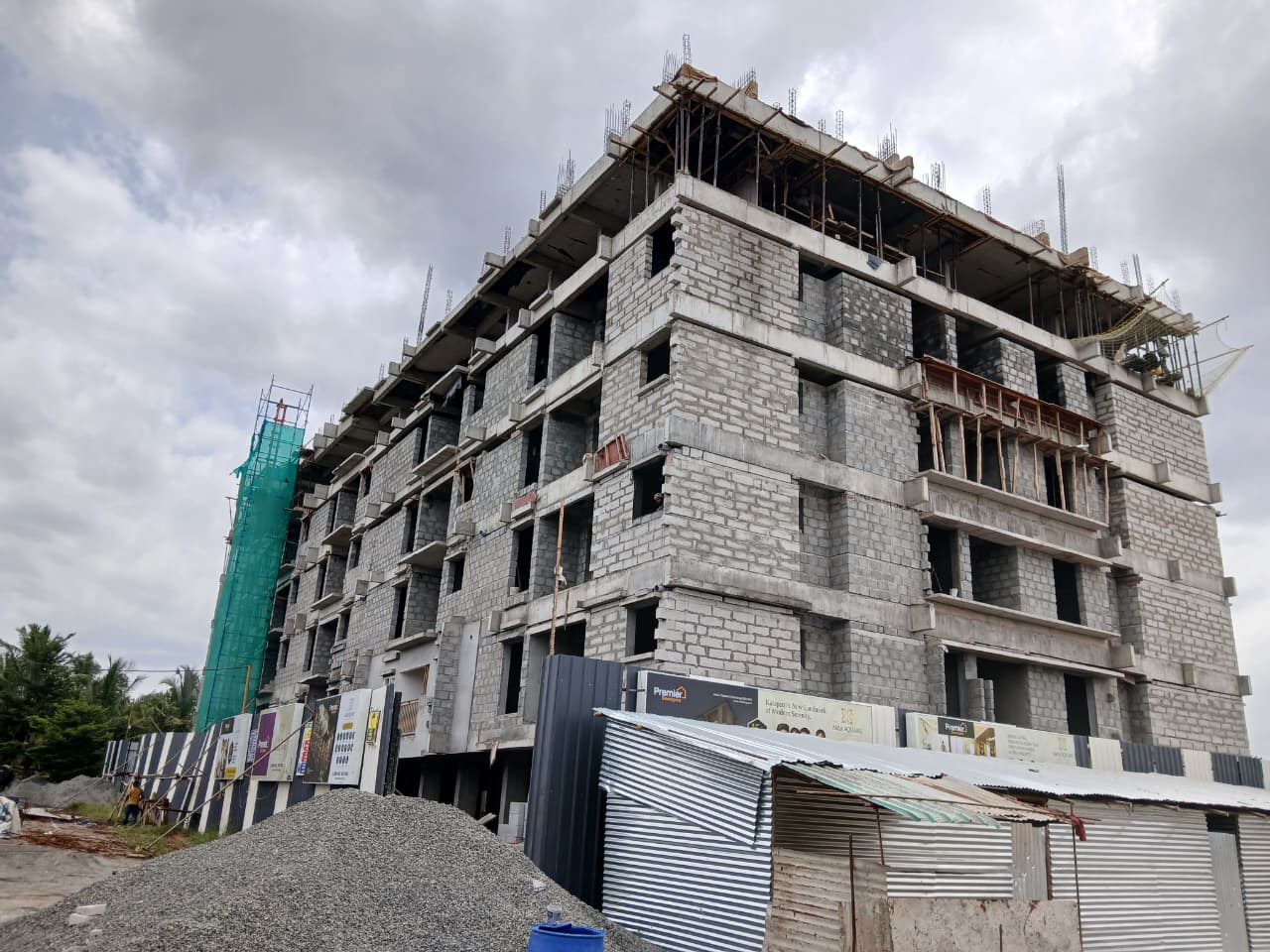

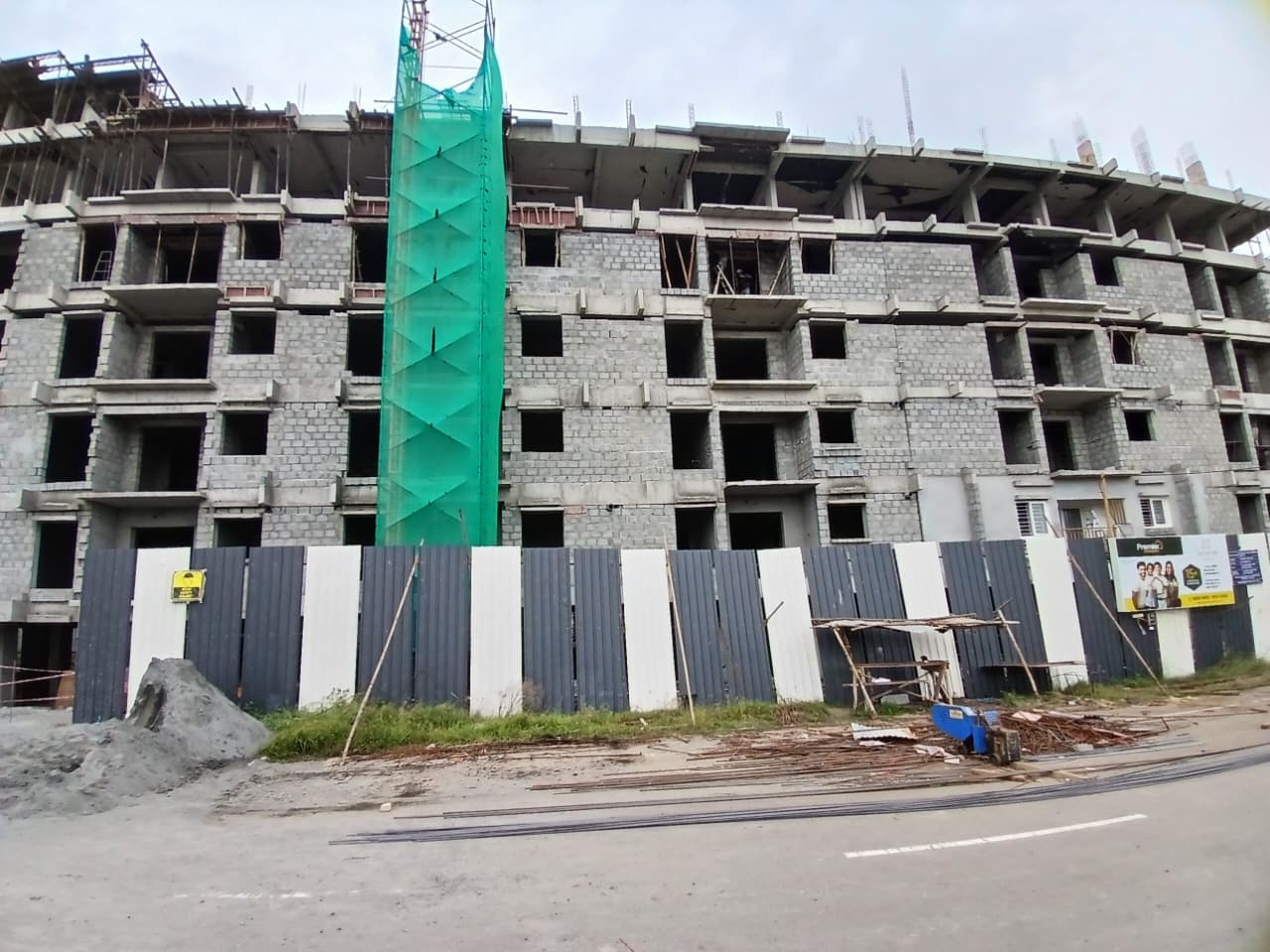

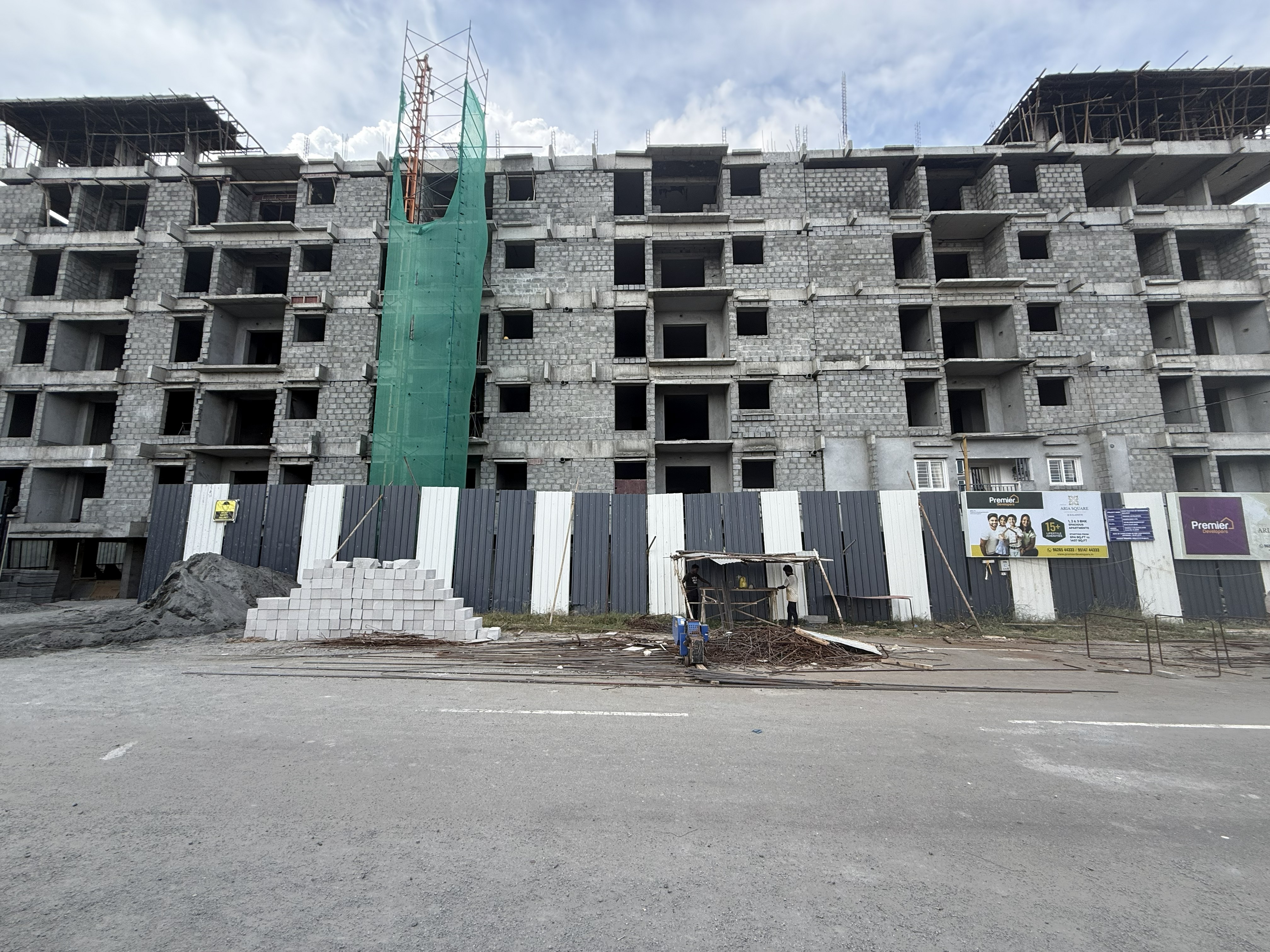

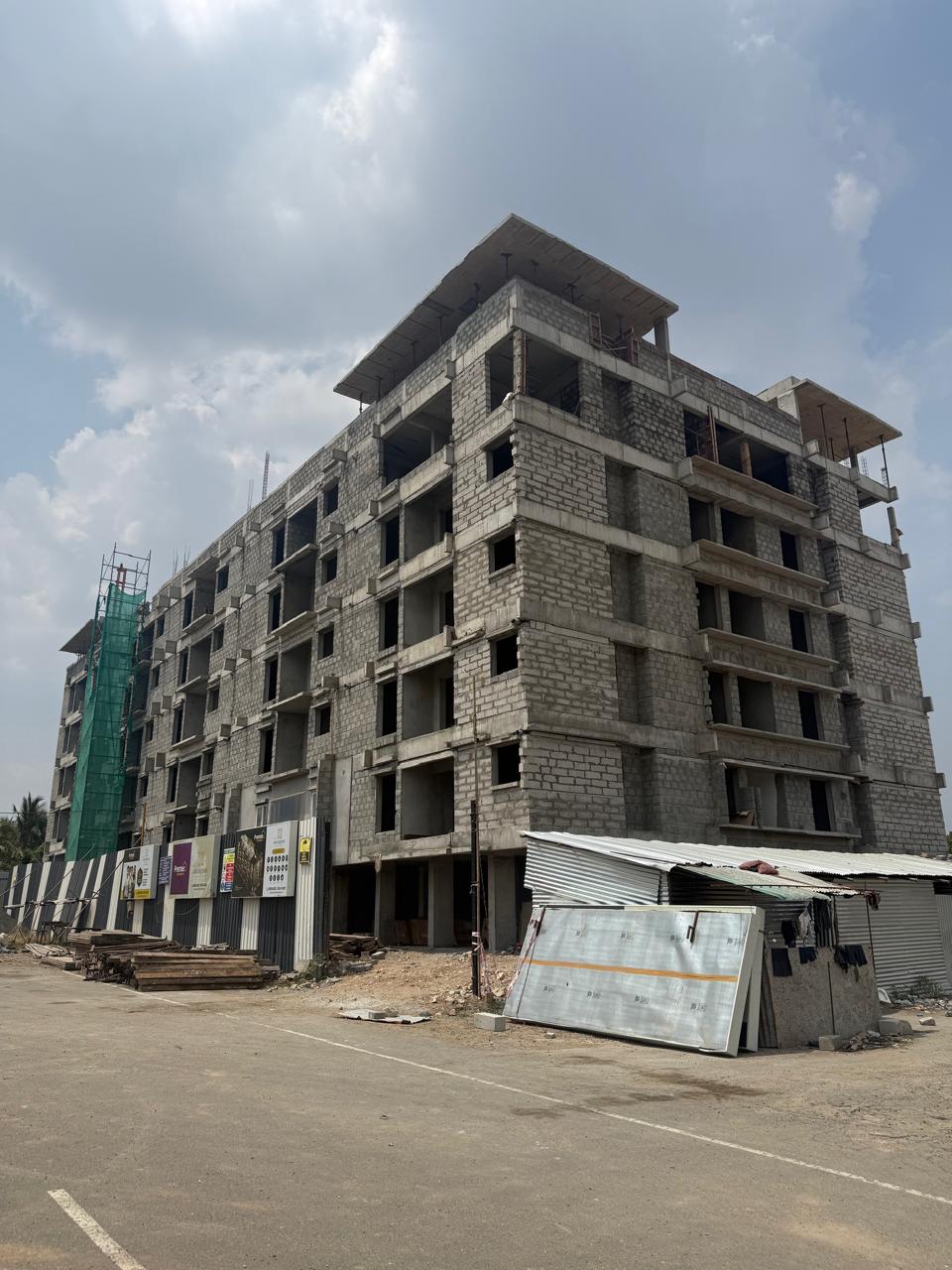

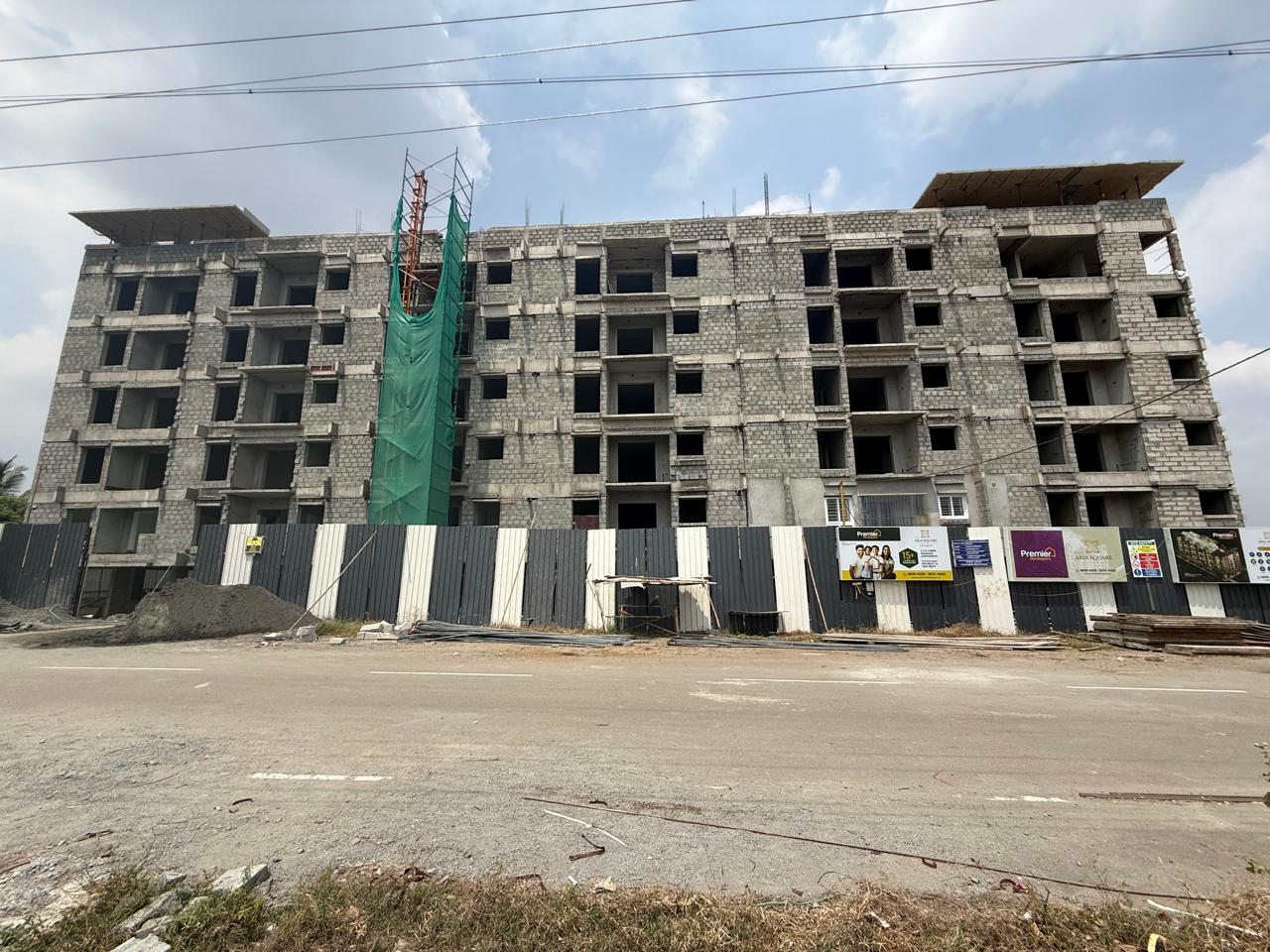

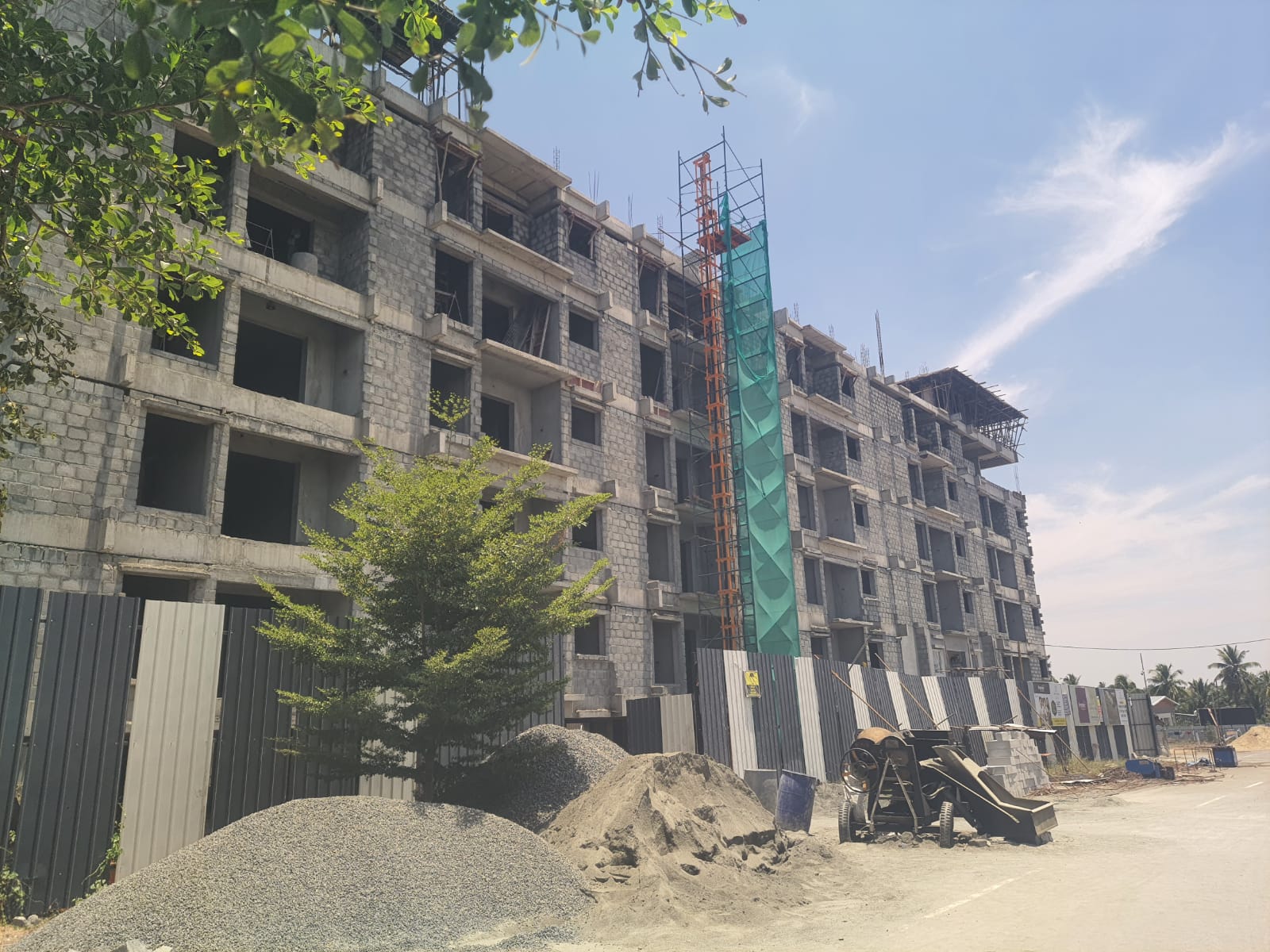

The five-floor structure and brickwork have been successfully completed across all floors.
Project Update
Brickwork have been successfully completed across all floors.
Project Update

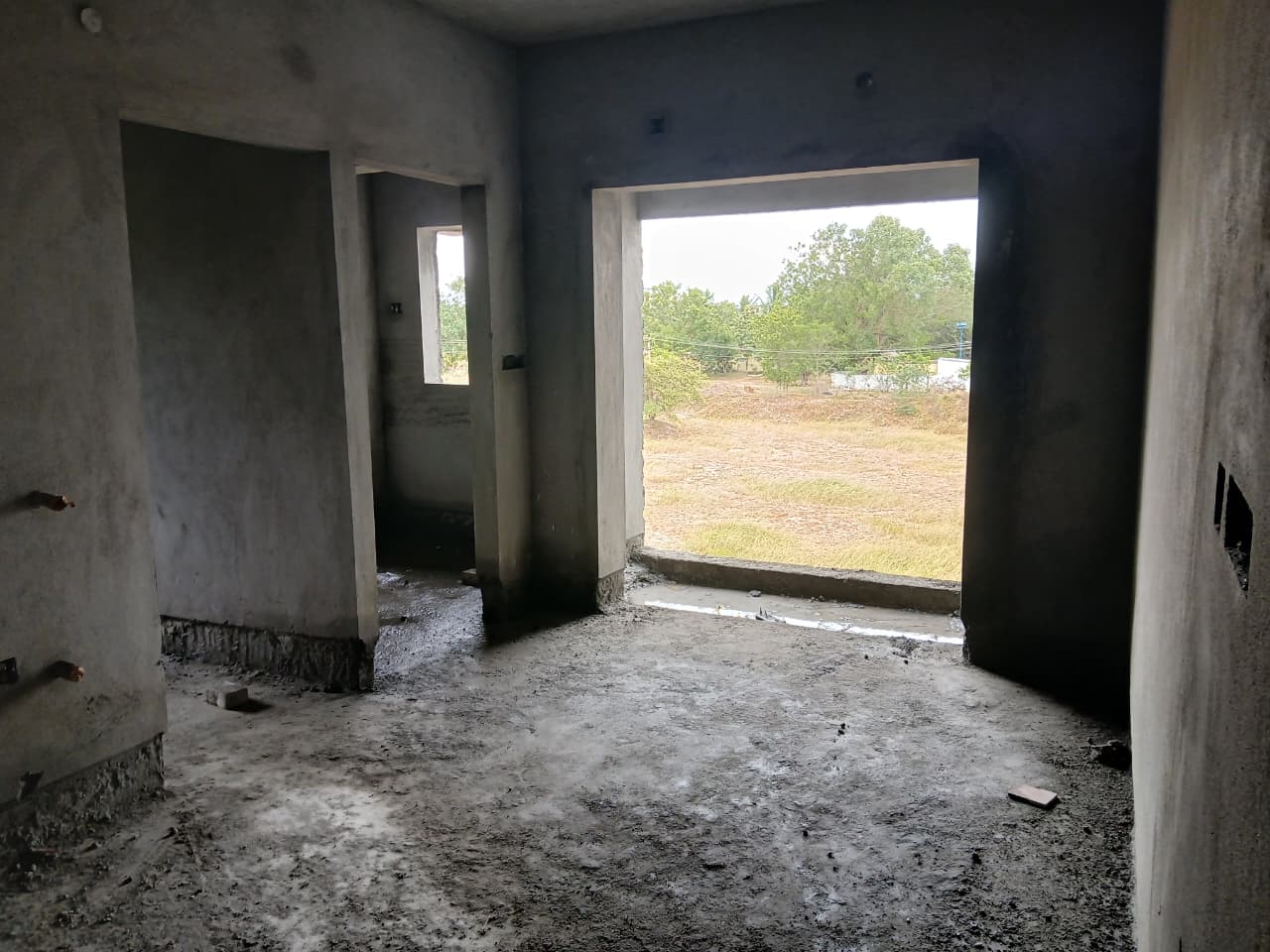

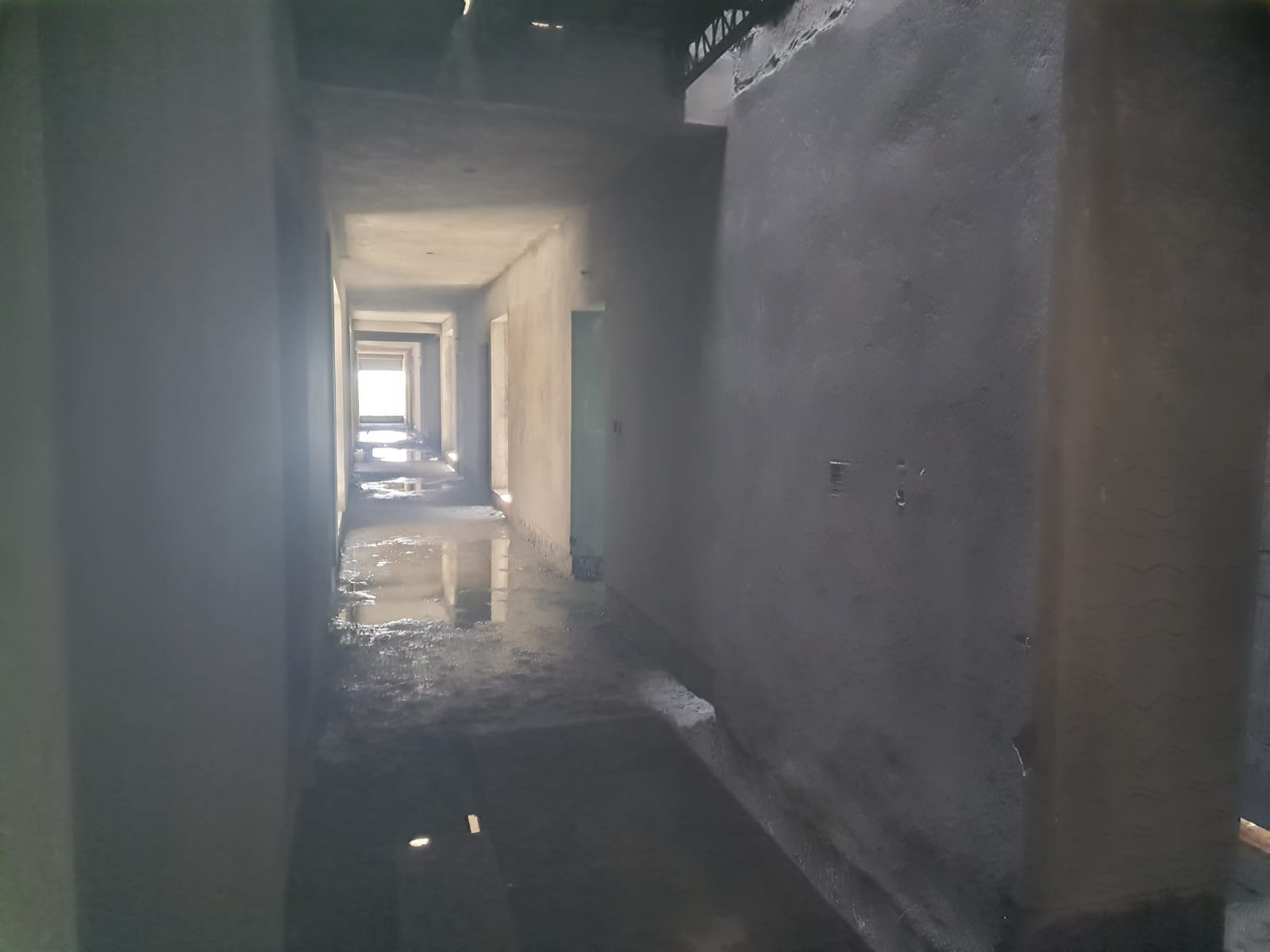

Plastering work: Inner plastering has been completed up to third Floor.
Project Update
Inner Plastering work for fourth floor is in the progress
Project Update
Terrace Floor: Head room work has been completed
Project Update
Terrace Floor: Head room work has been completed
Project Update
Terrace Floor: Head room work has been completed.
Project Update

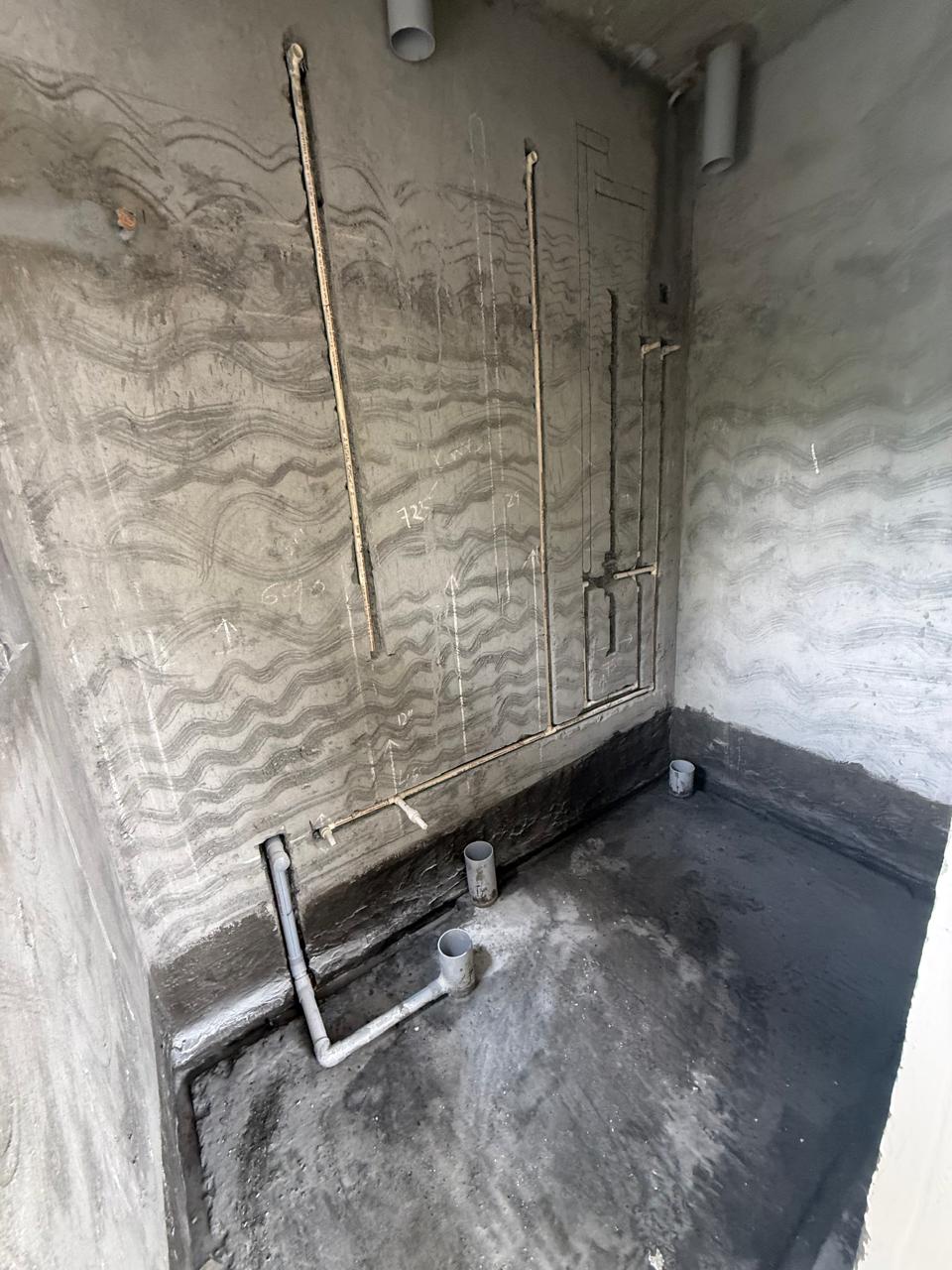

Plumbing work has been started in the first floor
Project Update
Plumbing work is in progress
Project Update
🏠 Our Model House is Ready for Viewing! We’re delighted to invite you to visit and experience the space firsthand. We look forward to welcoming you!
Project Update

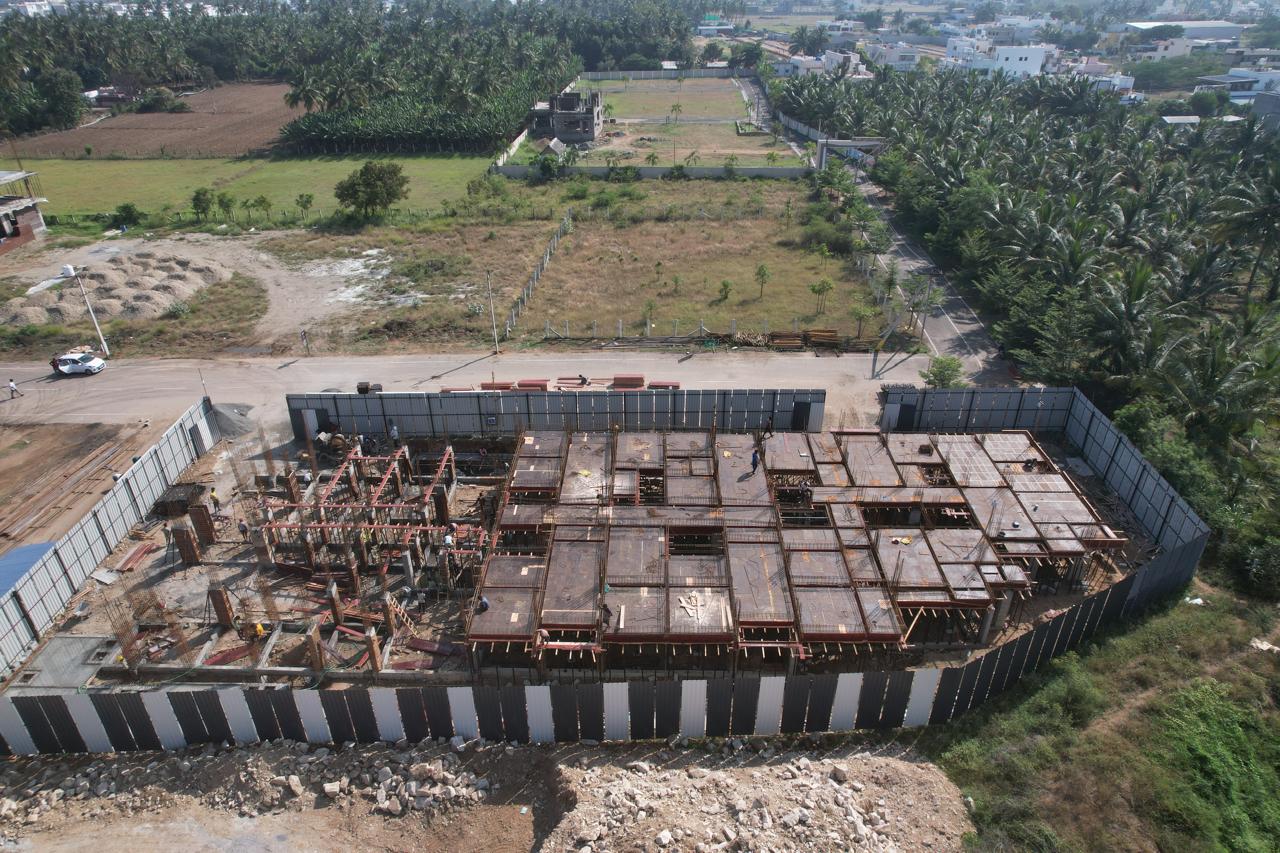

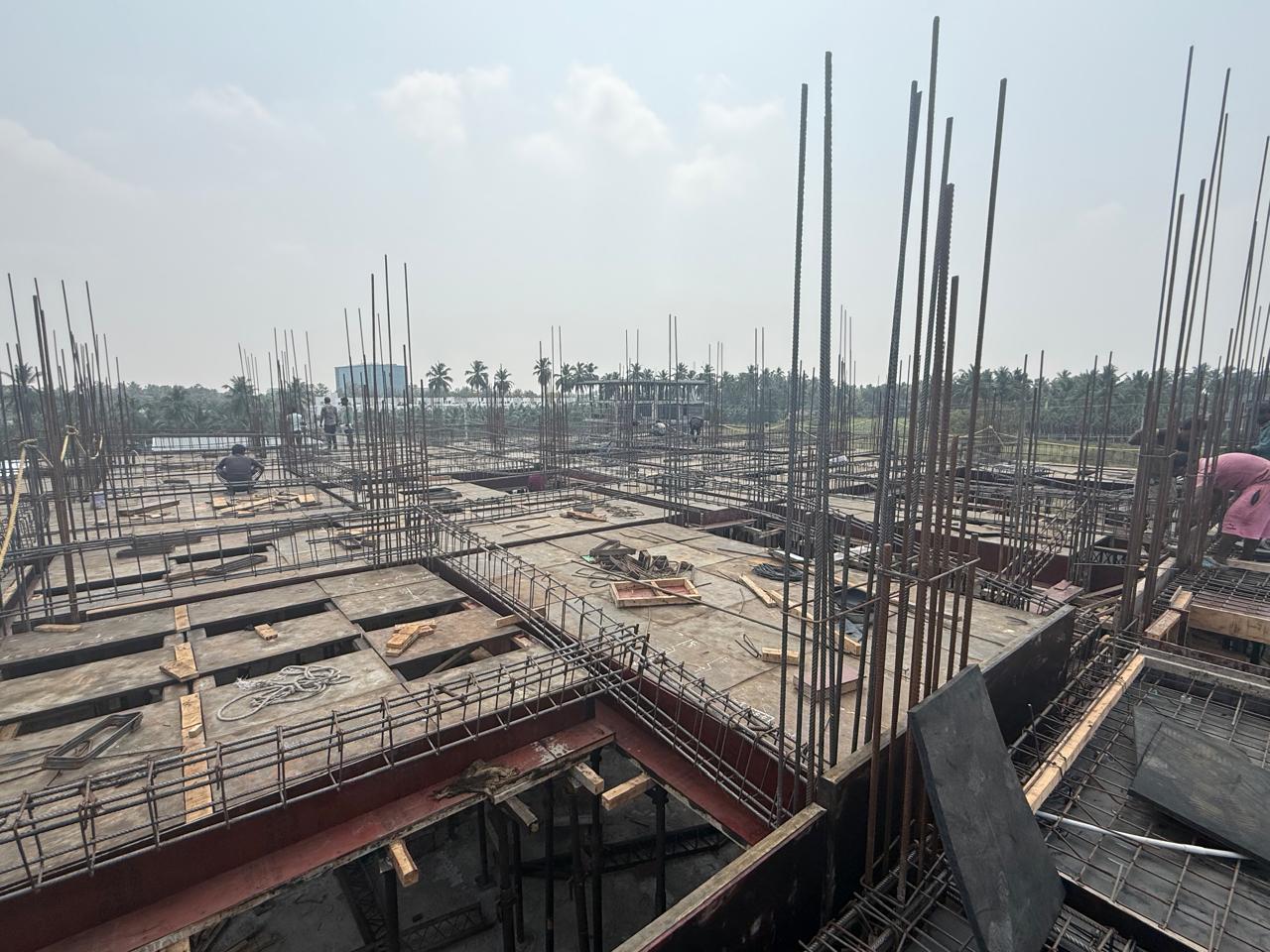

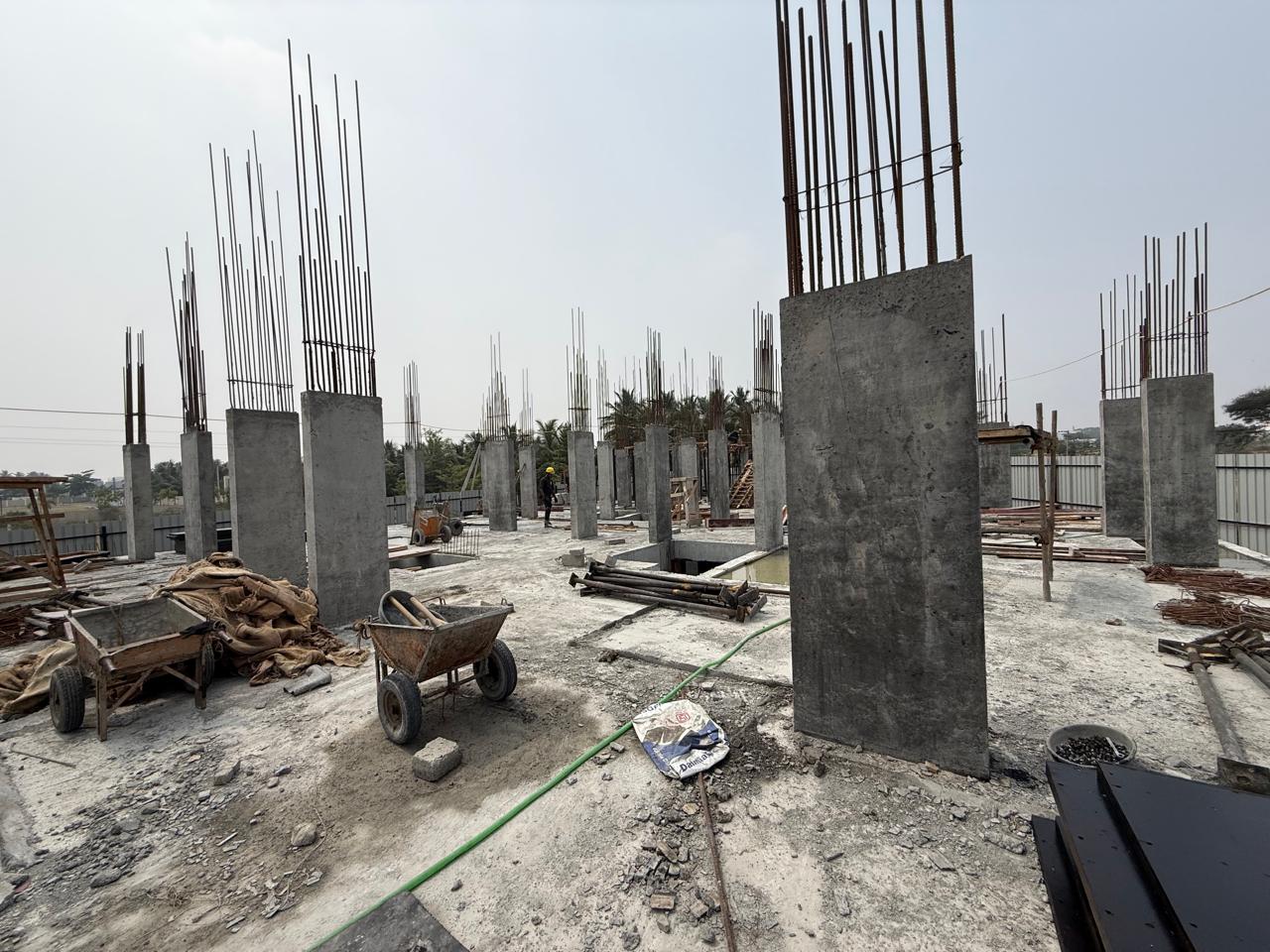

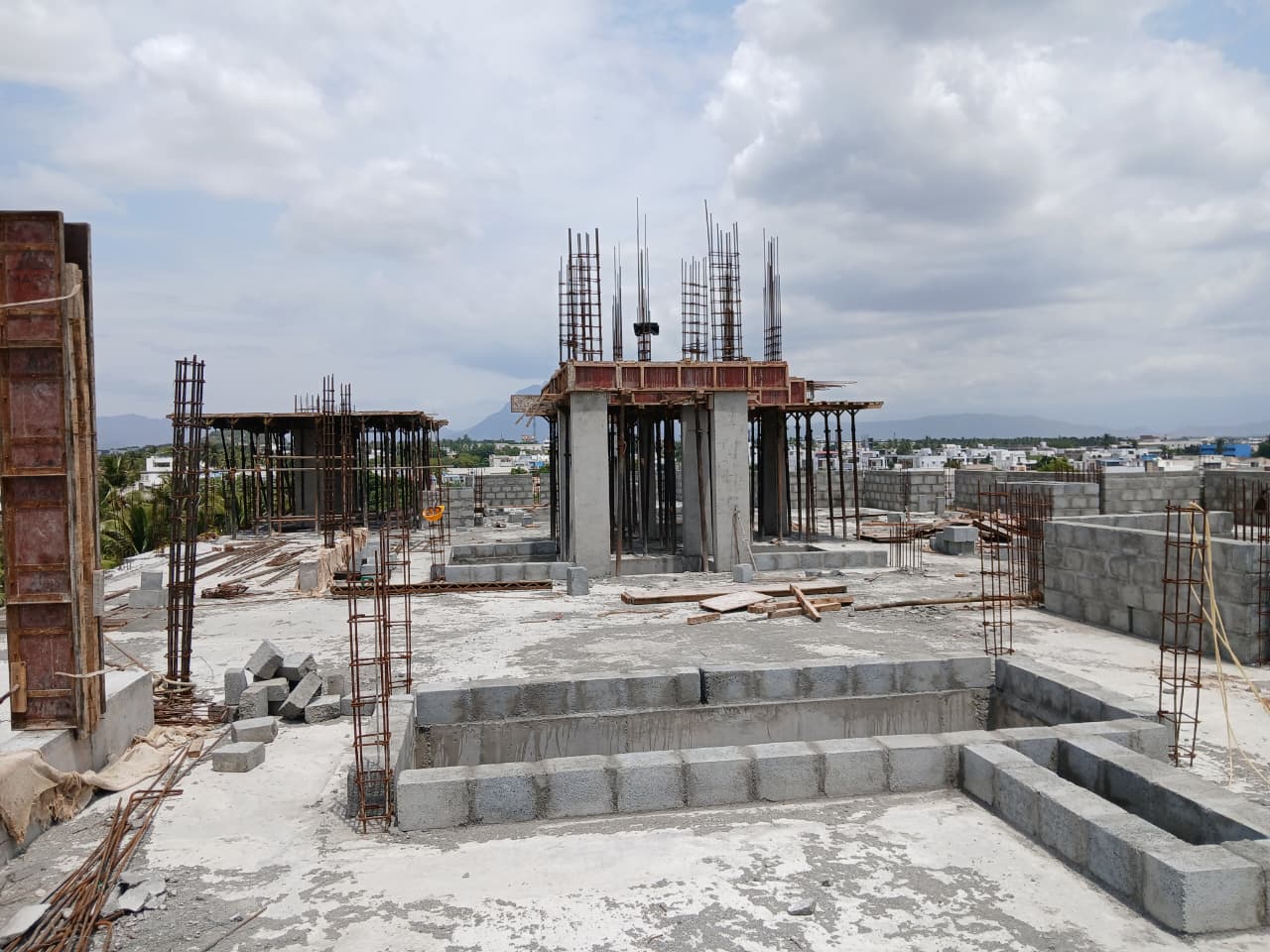

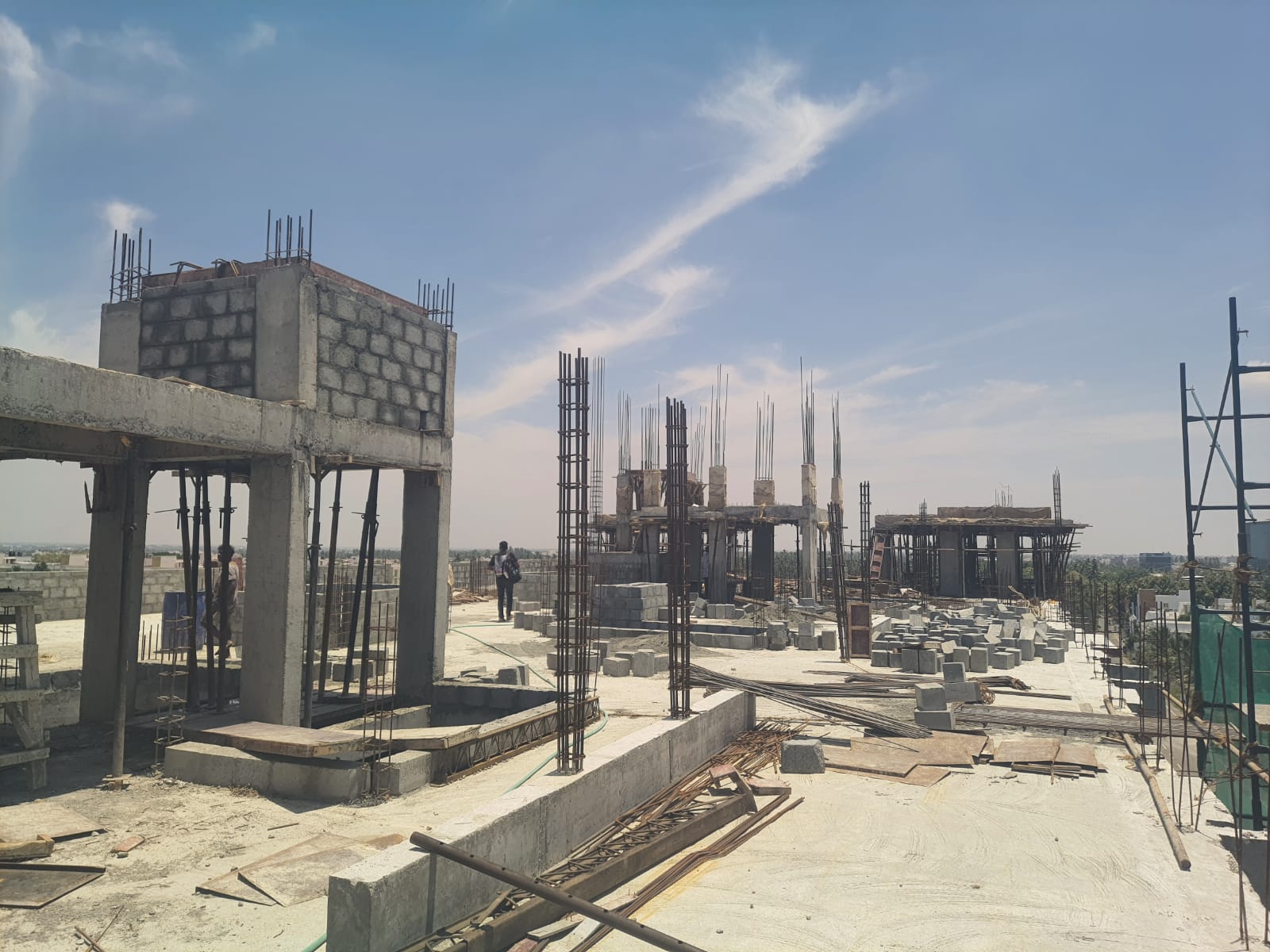

Floor Slab: Structural work for all 5 floors has been completed.
Project Update

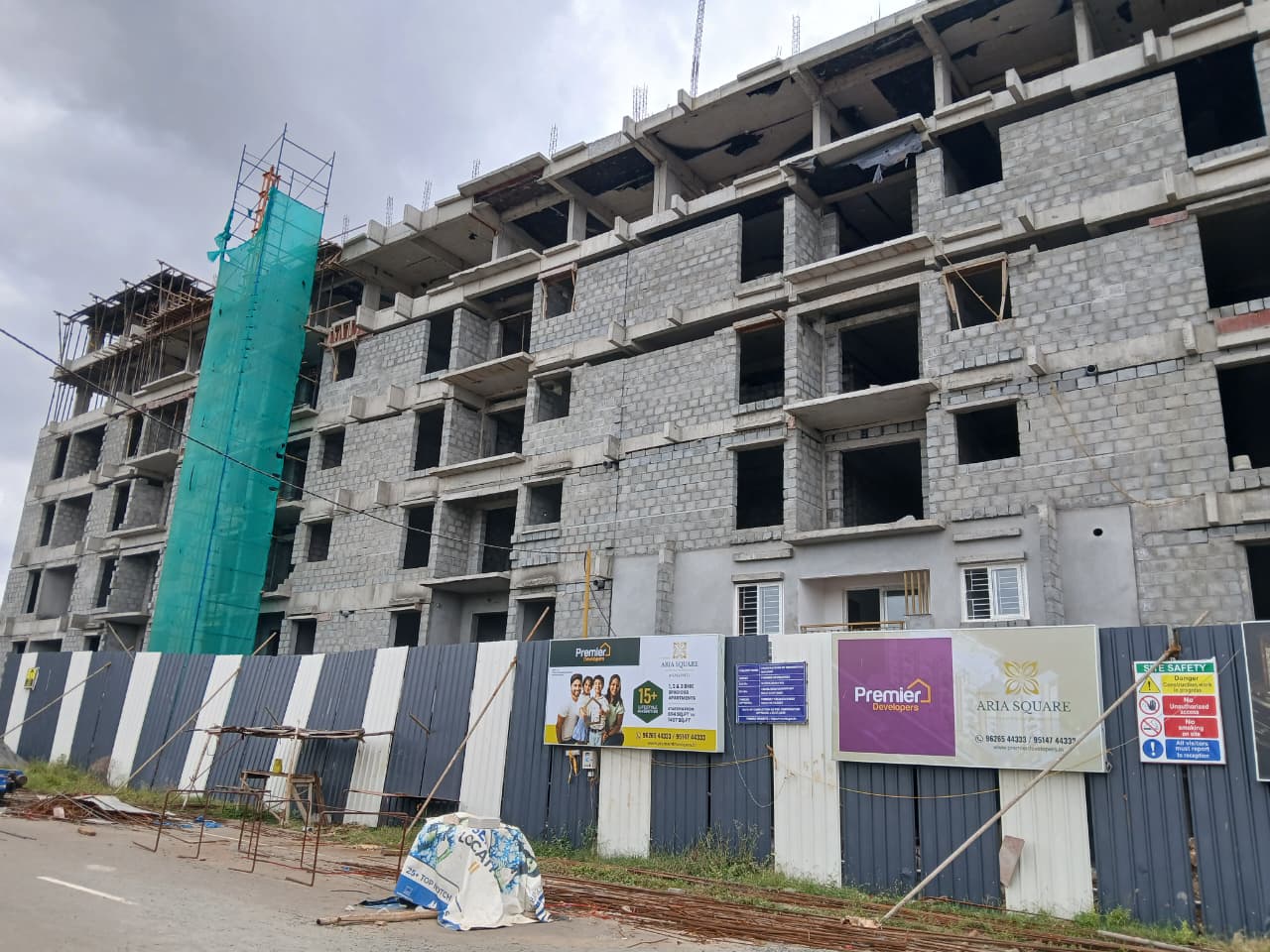

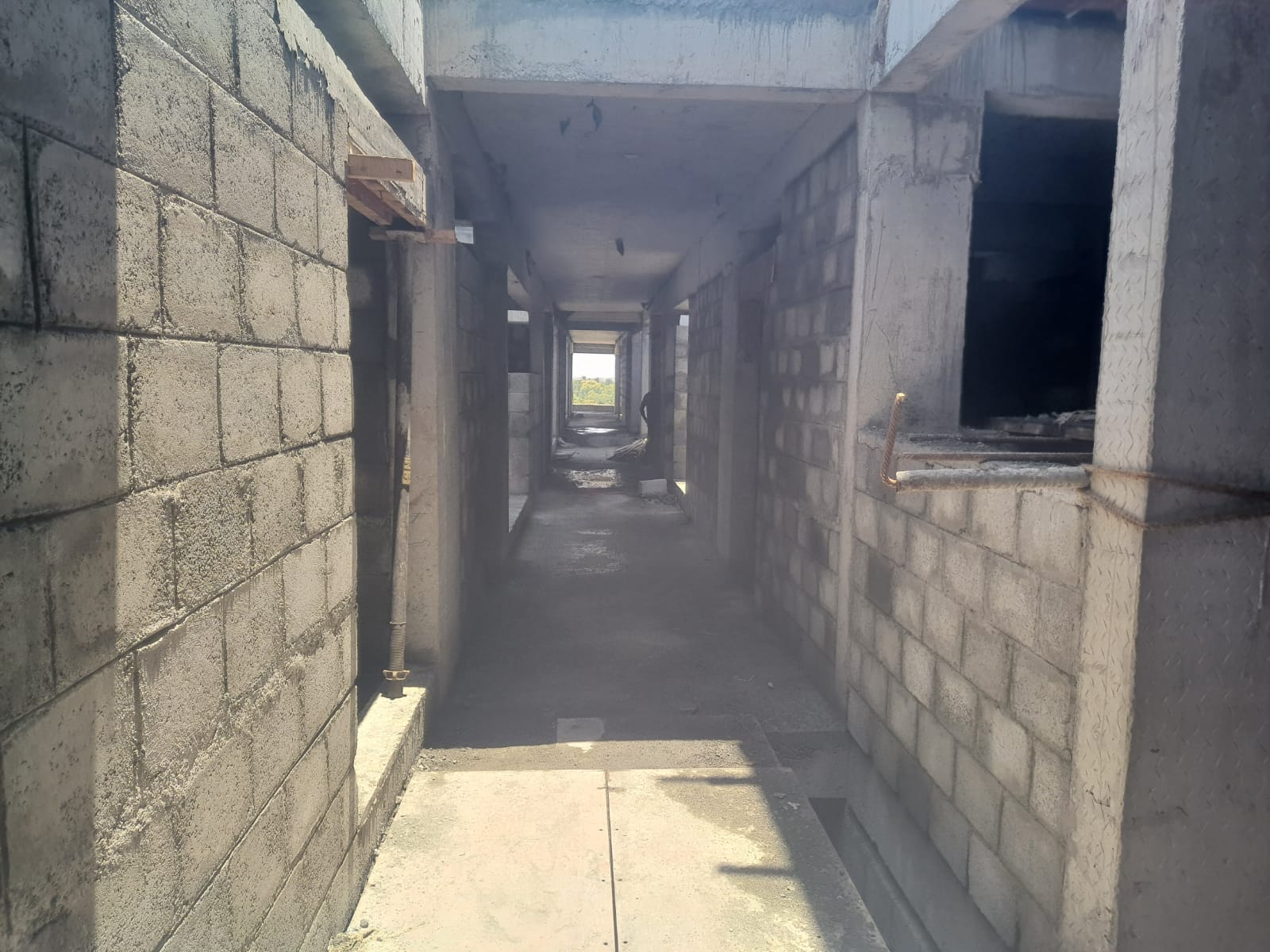

Brick work has been completed up to the 4th Floor.
Project Update
Brick work has been completed upto the fourth floor.
Project Update

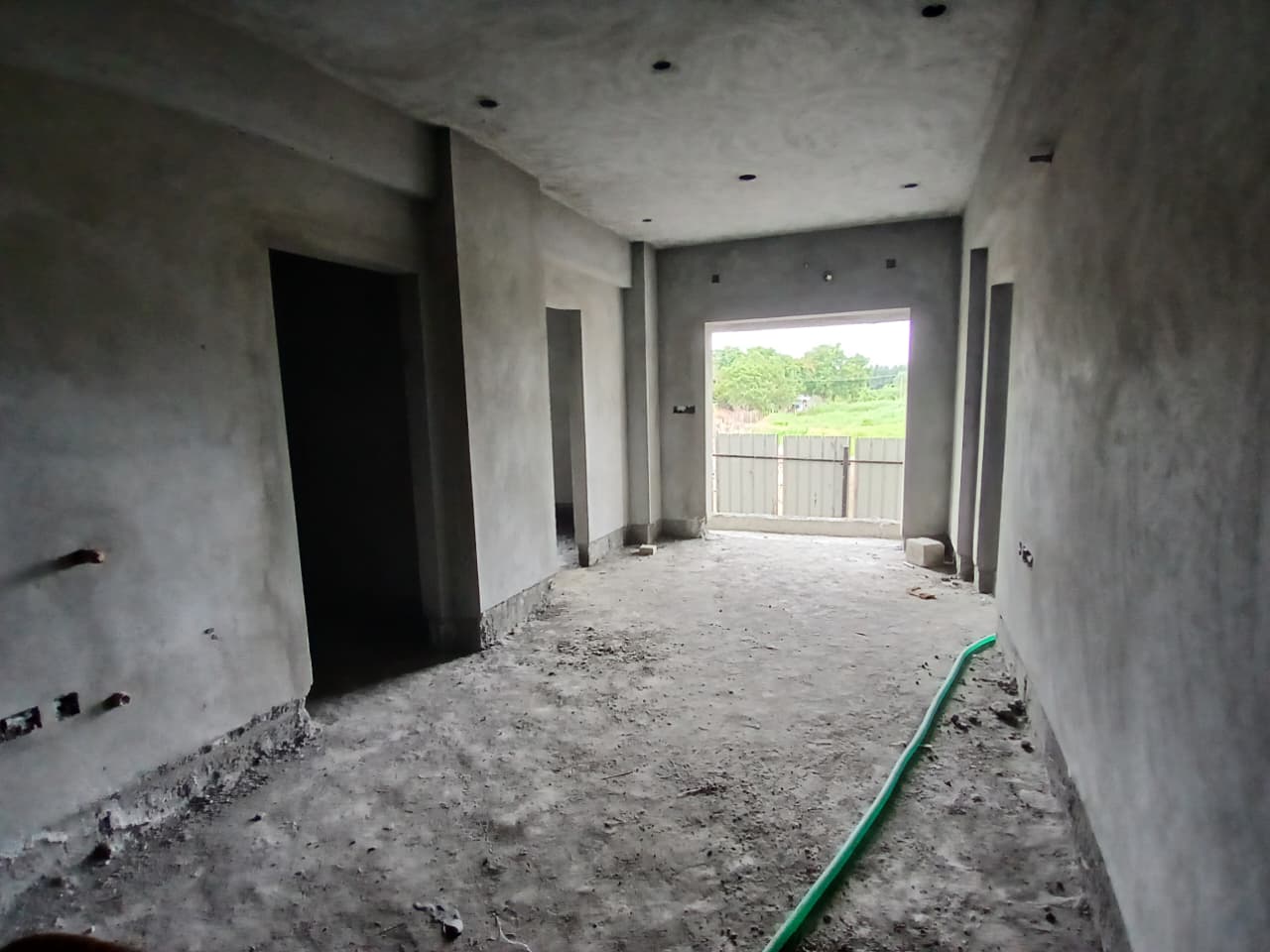

Plastering work: Inner Plastering is completed in the first floor.
Project Update
Plastering work: Inner plastering work is going on in the second floor.
Project Update
Terrace Floor: Head room work is in progress.
Project Update
Terrace Floor: Head room work is in progress.
Project Update
Terrace Floor: Head room work is in progress.
Project Update

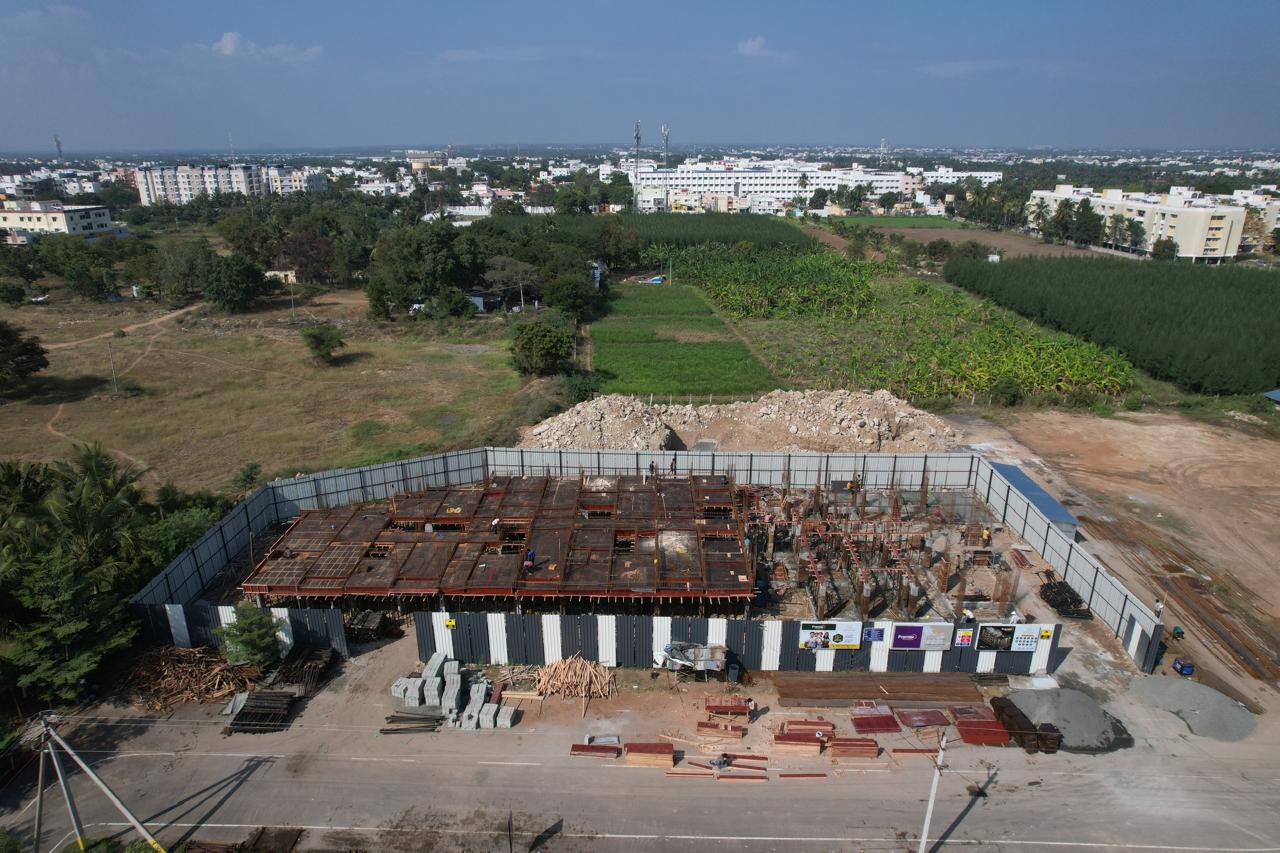

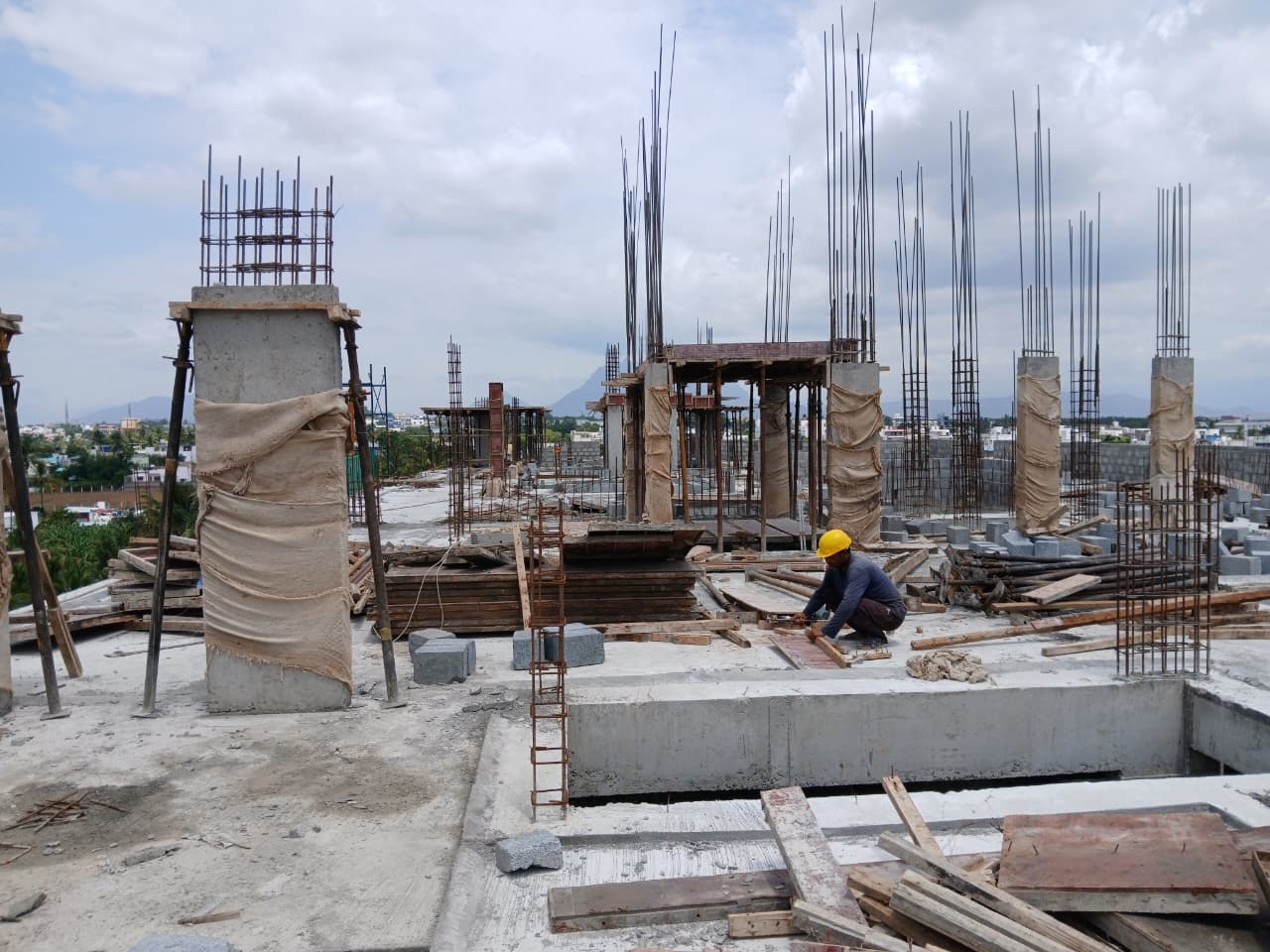

Fifth Floor - 50% -concrete work is done, and 50% - shuttering work is in progress
Project Update
Third Floor Block work has been completed and Fourth floor block work in progress
Project Update
Fourth Floor - 50% -concrete work is done, and 50% - shuttering work is in progress
Project Update

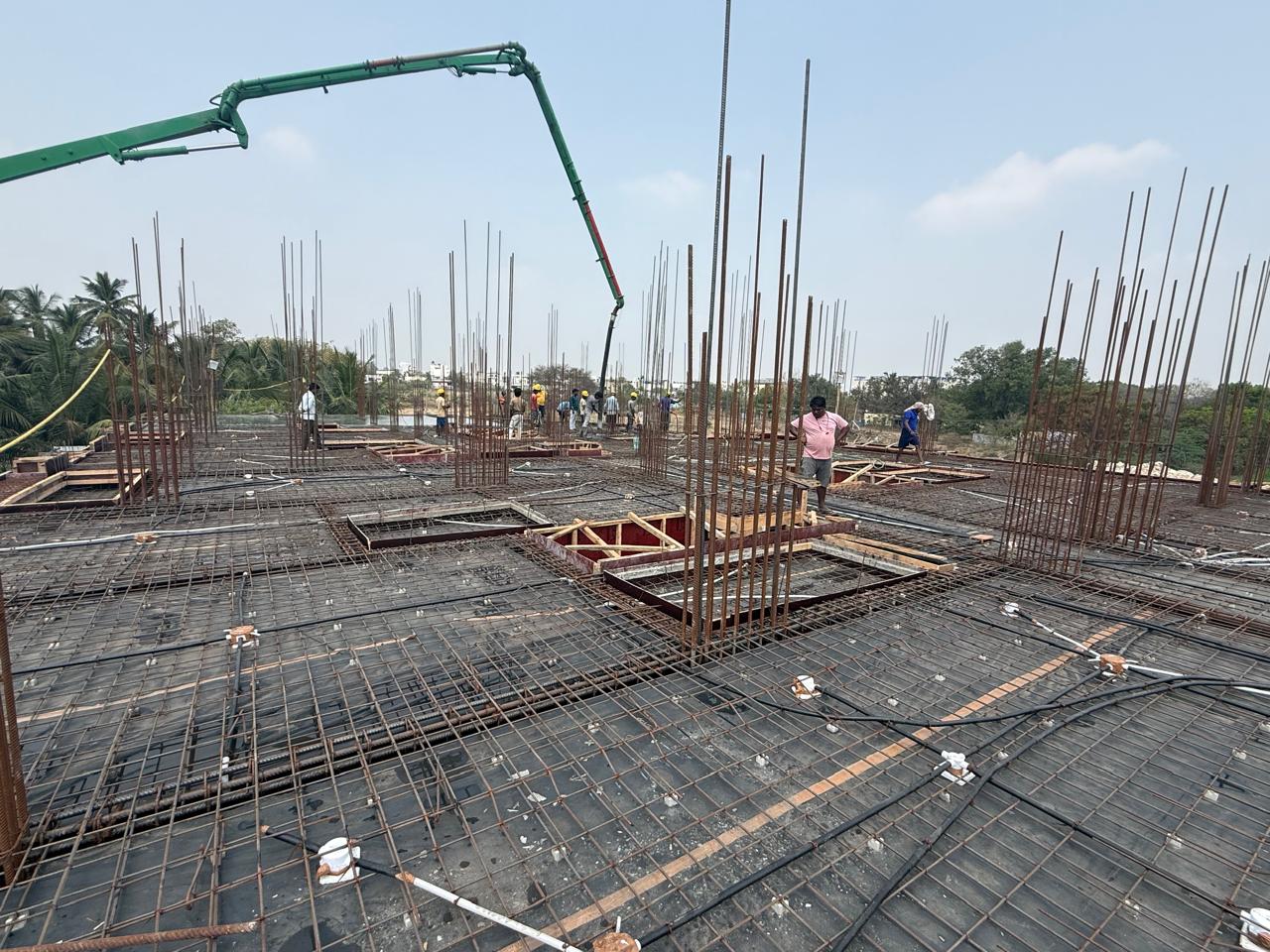

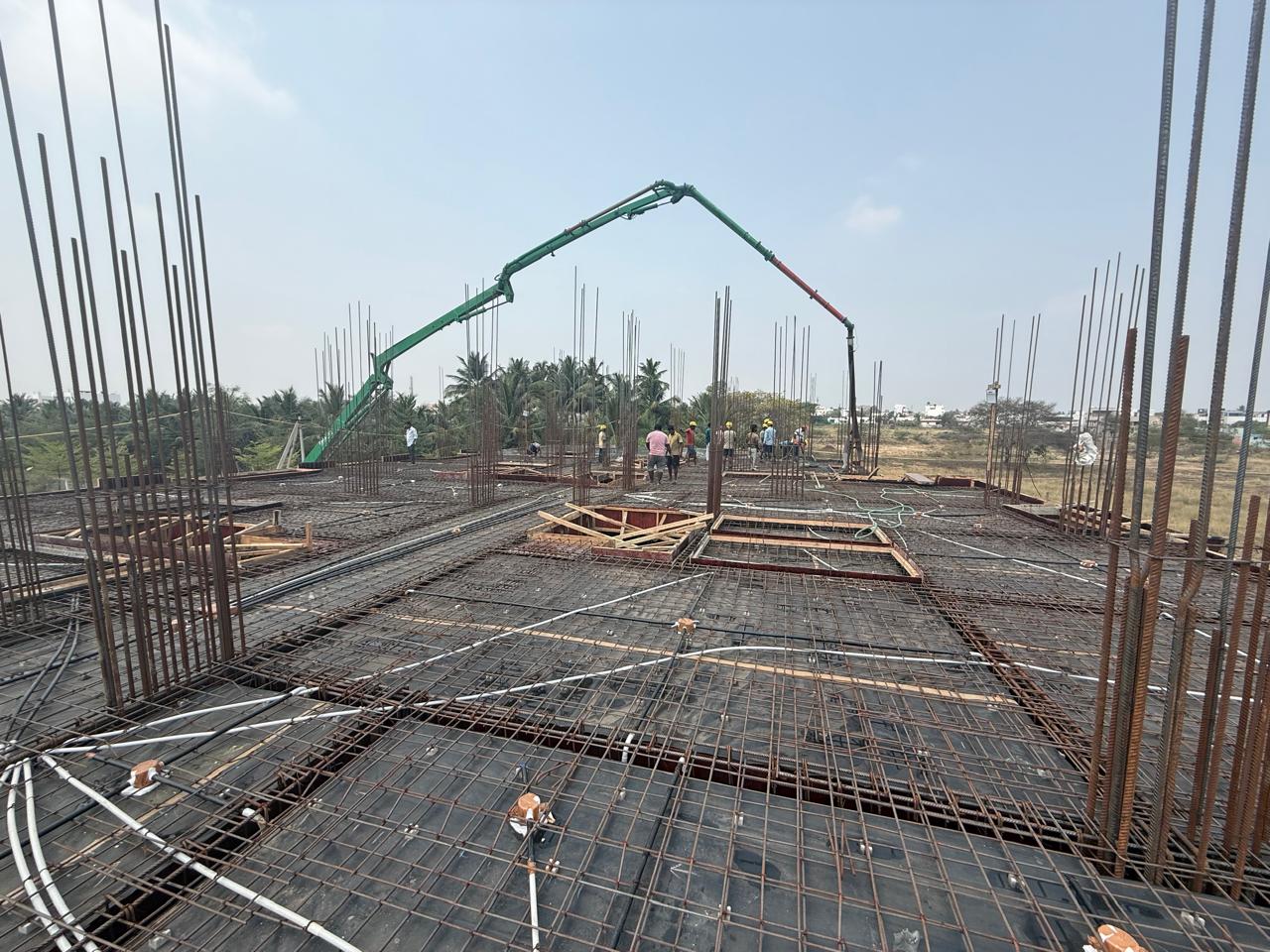

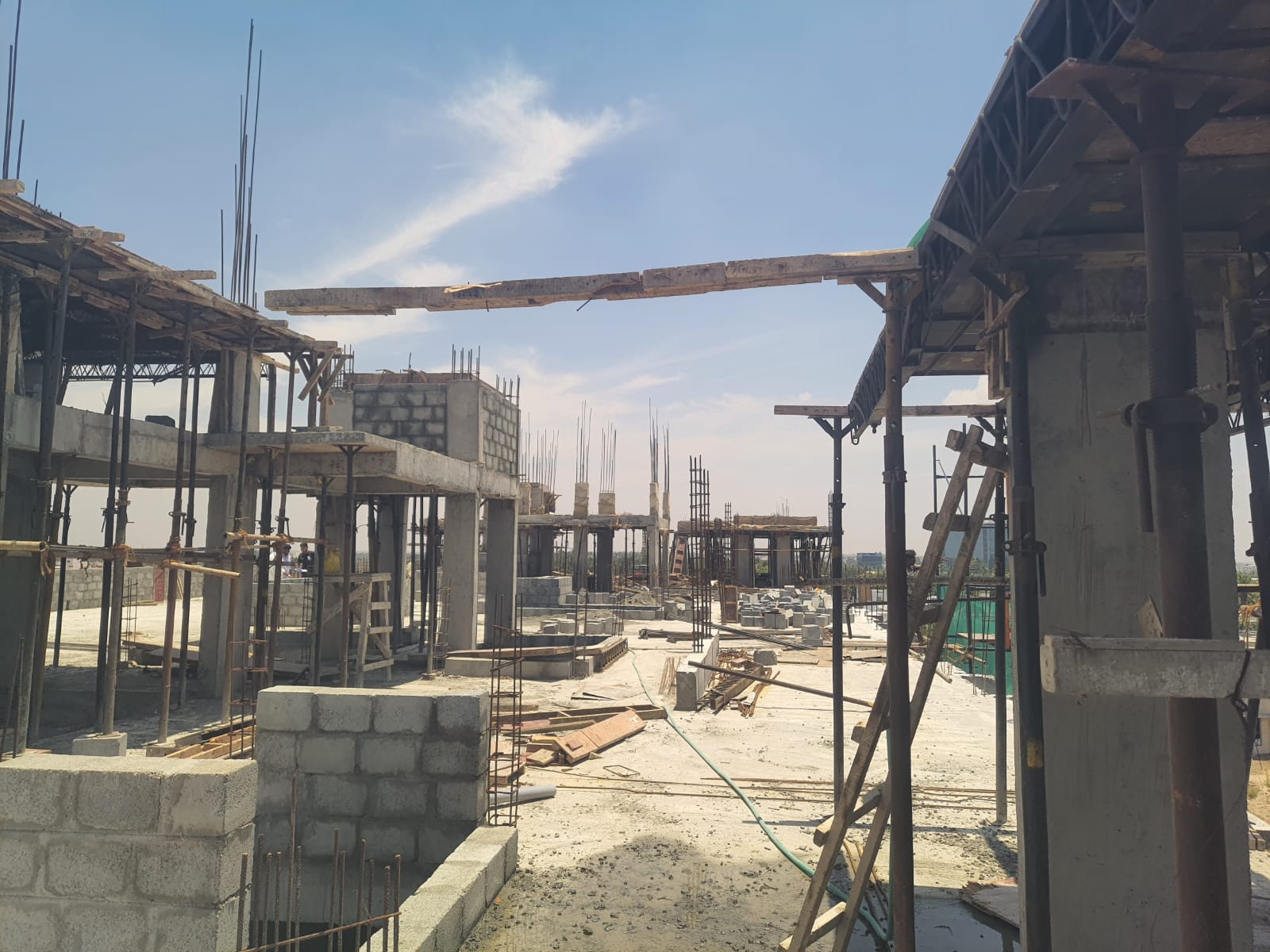

One part of Fourth floor slab- Concrete work has been completed
Project Update
Another part of Fourth floor slab - Shuttering work is going on.
Project Update
First floor- Block work has been completed. Second Floor- Block work has been partially completed
Project Update
May Updates..
Project Update
May updates
Project Update
May updates..
Project Update
May updates...
Project Update
Third Floor - 50% -concrete work is done, and 50% - shuttering work is in progress
Project Update
One part of Third floor slab - Concrete work has been completed
Project Update
Another part of Third floor slab, Shuttering work is going on
Project Update
First floor brick work is in progress
Project Update
Second Floor brick work will be started.
Project Update
Second Floor - concrete work is halfway done, and shuttering work for the rest is in progress
Project Update

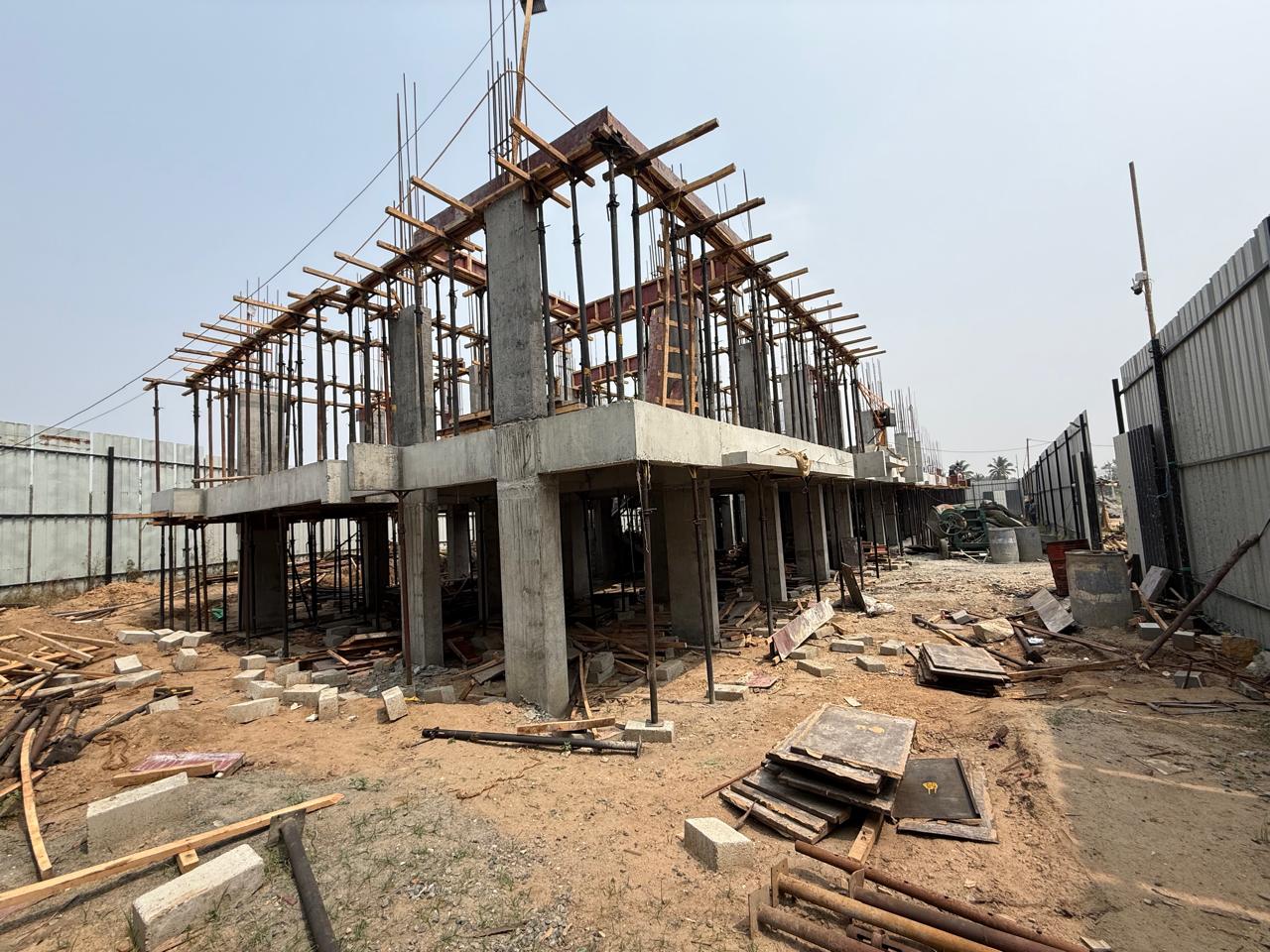

π‚π‘π€π…π“πˆππ† 𝐀 π‹π„π†π€π‚π˜ β€” 𝐎𝐧𝐞 𝐁𝐫𝐒𝐜𝐀 𝐚𝐭 𝐚 π“π’π¦πž β€”: First Floor Brick Work has been started.
Project Update
First Floor - Brick Work in action
Project Update

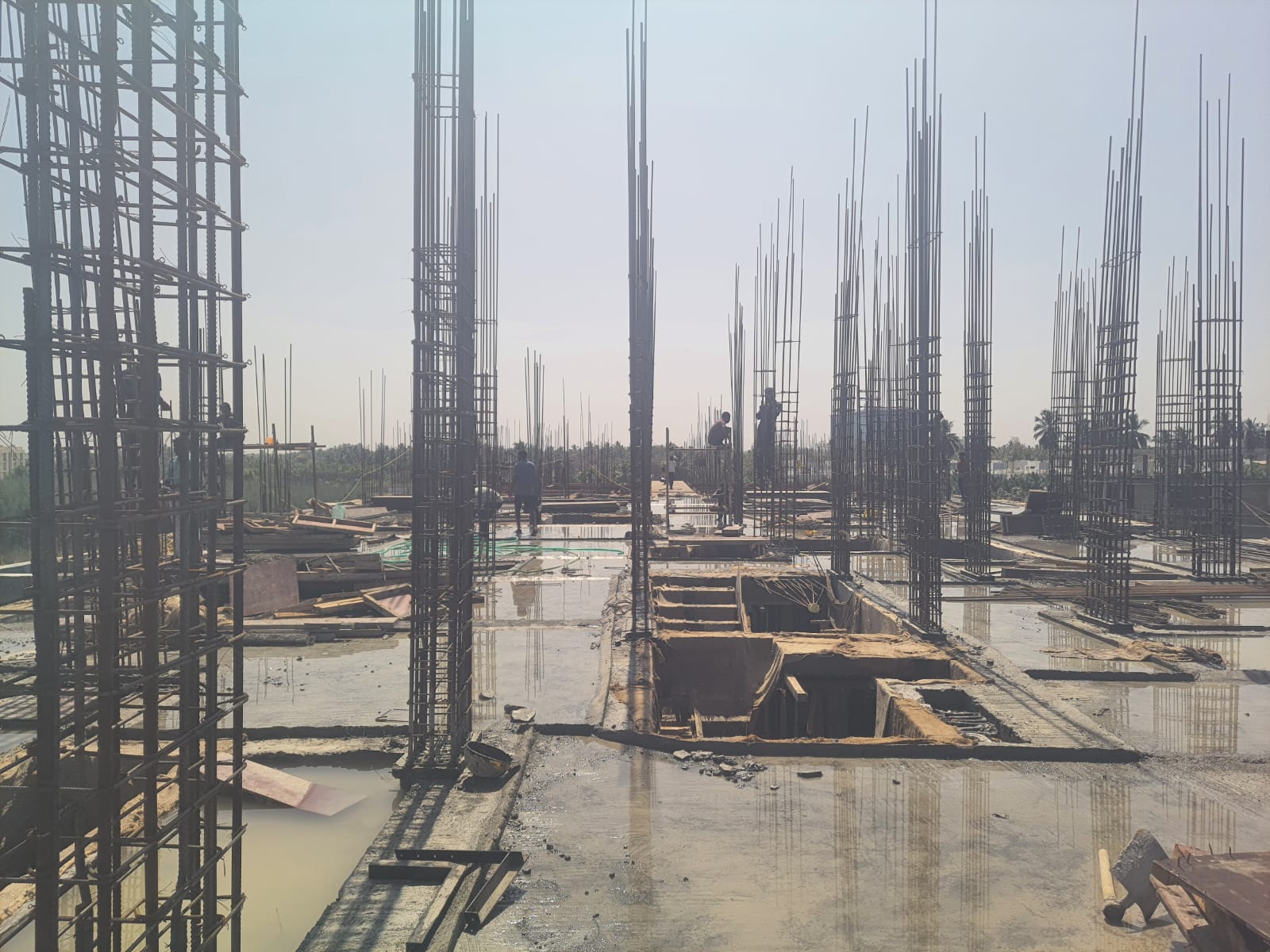

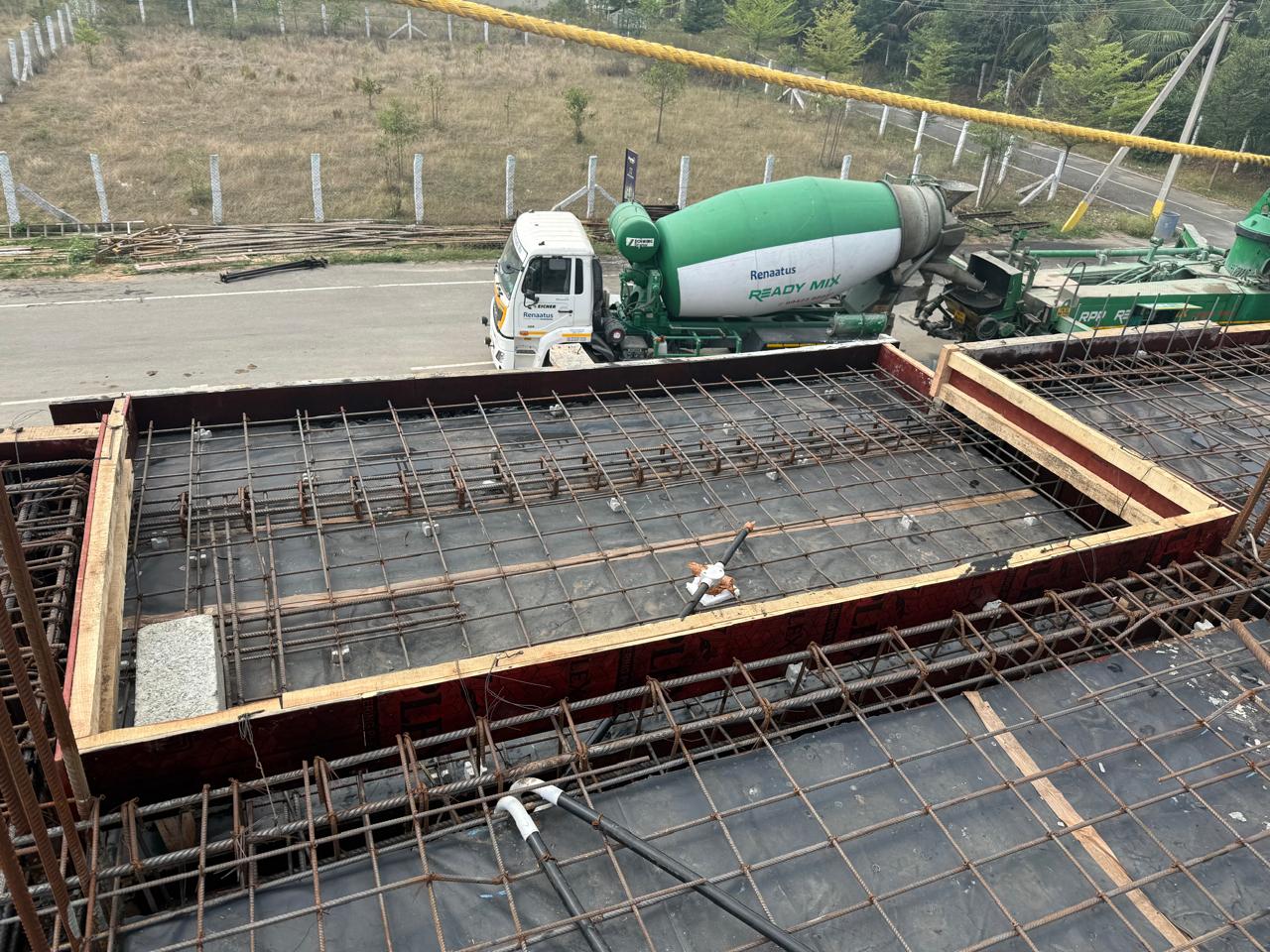

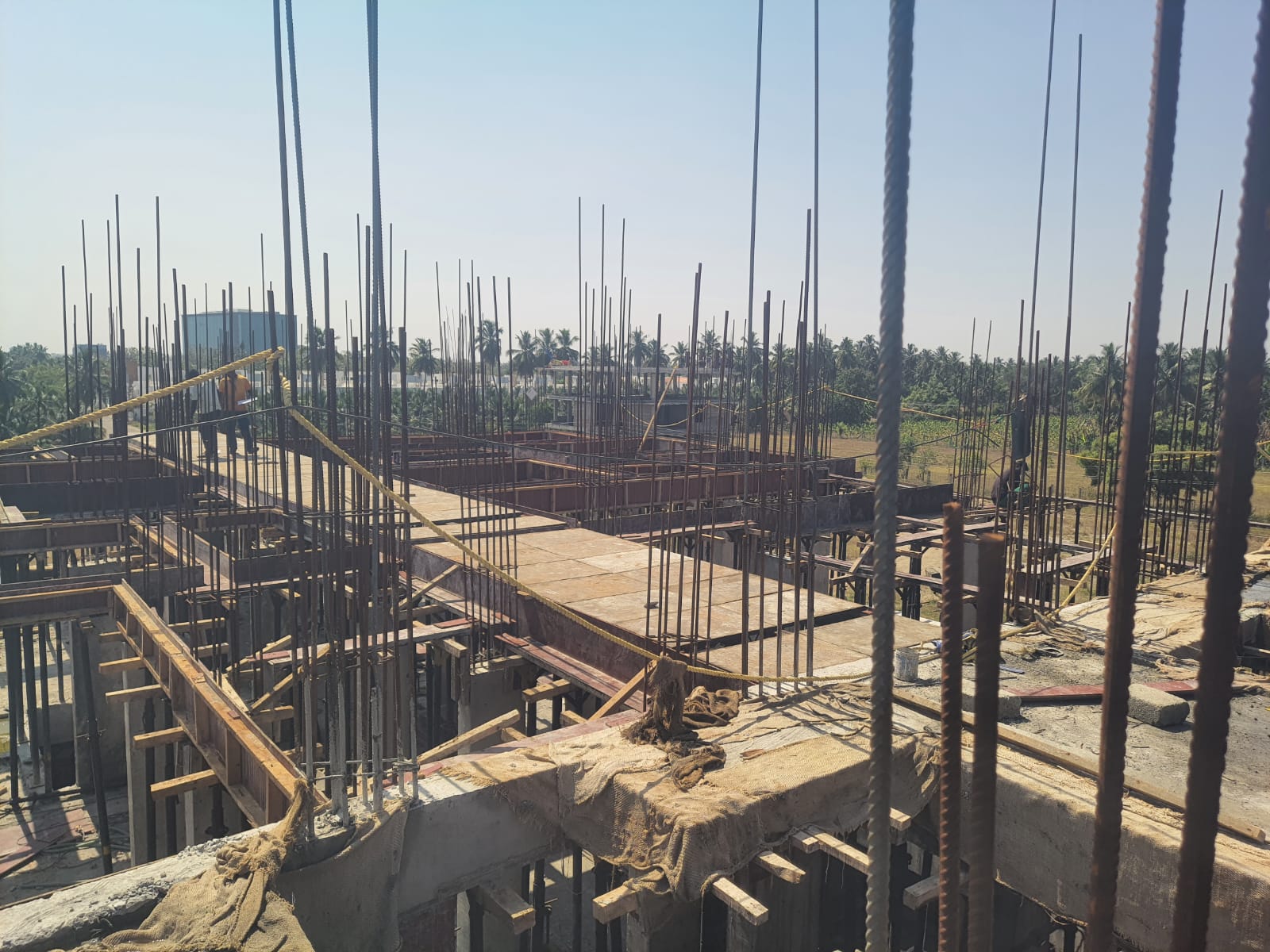

One part of Second floor roof concrete work has been completed
Project Update
Another part of Second Floor roof shuttering work is going on
Project Update
Another part of Second Floor roof shuttering work in progress
Project Update

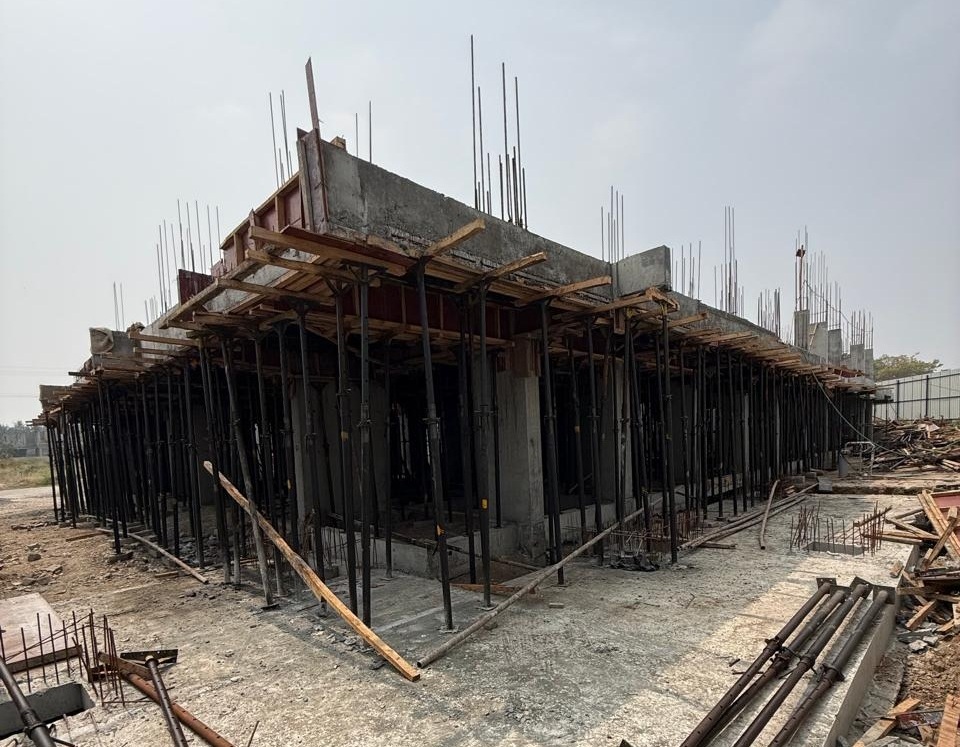

One part of the First floor roof concrete work has been completed.
Project Update
One part of the First floor roof concrete work has been completed.
Project Update
One part of the First floor roof concrete work has been completed.
Project Update
One part of the First floor roof concrete work has been completed.
Project Update
Shuttering work is going on in another part of the First floor
Project Update

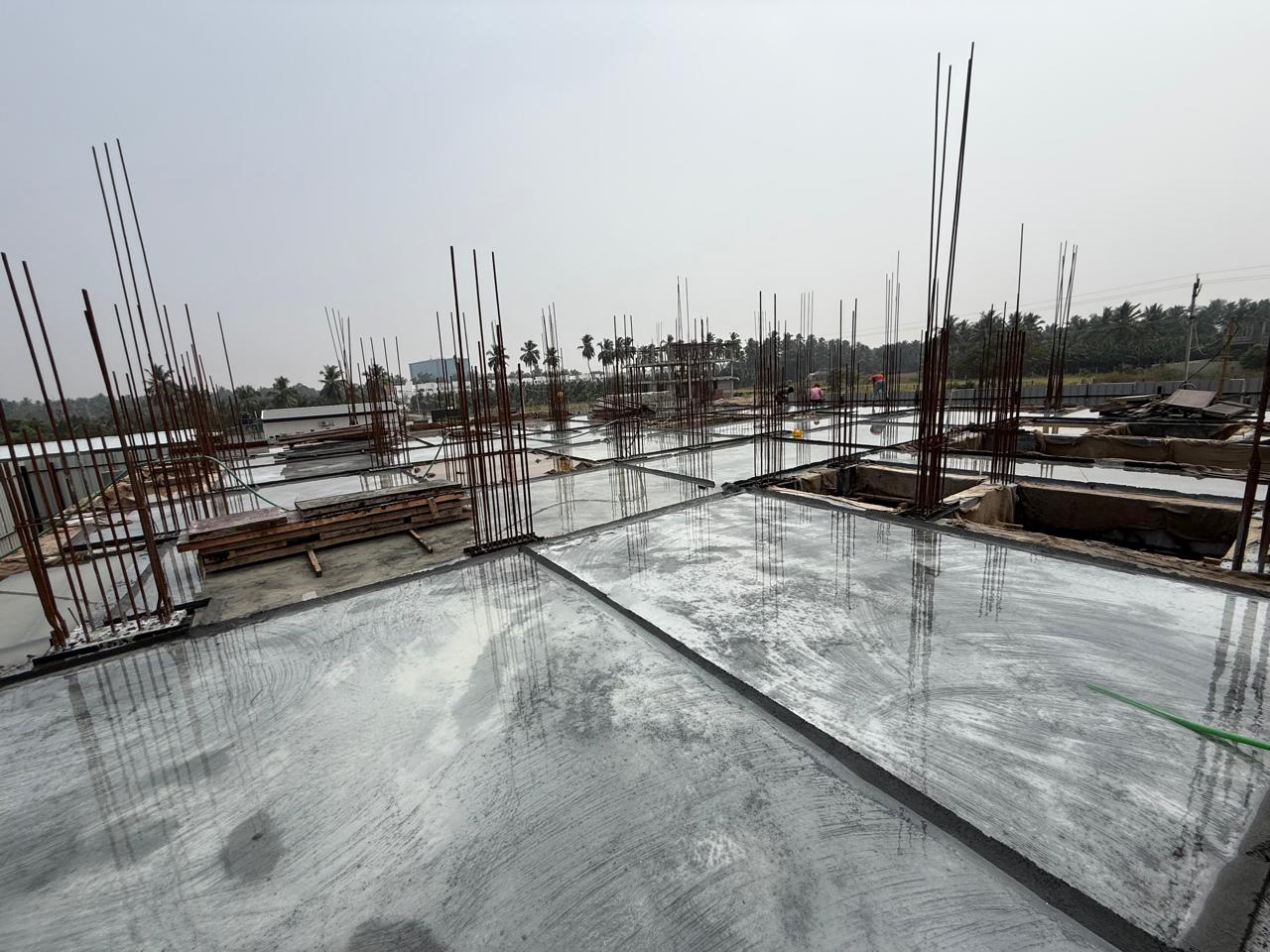

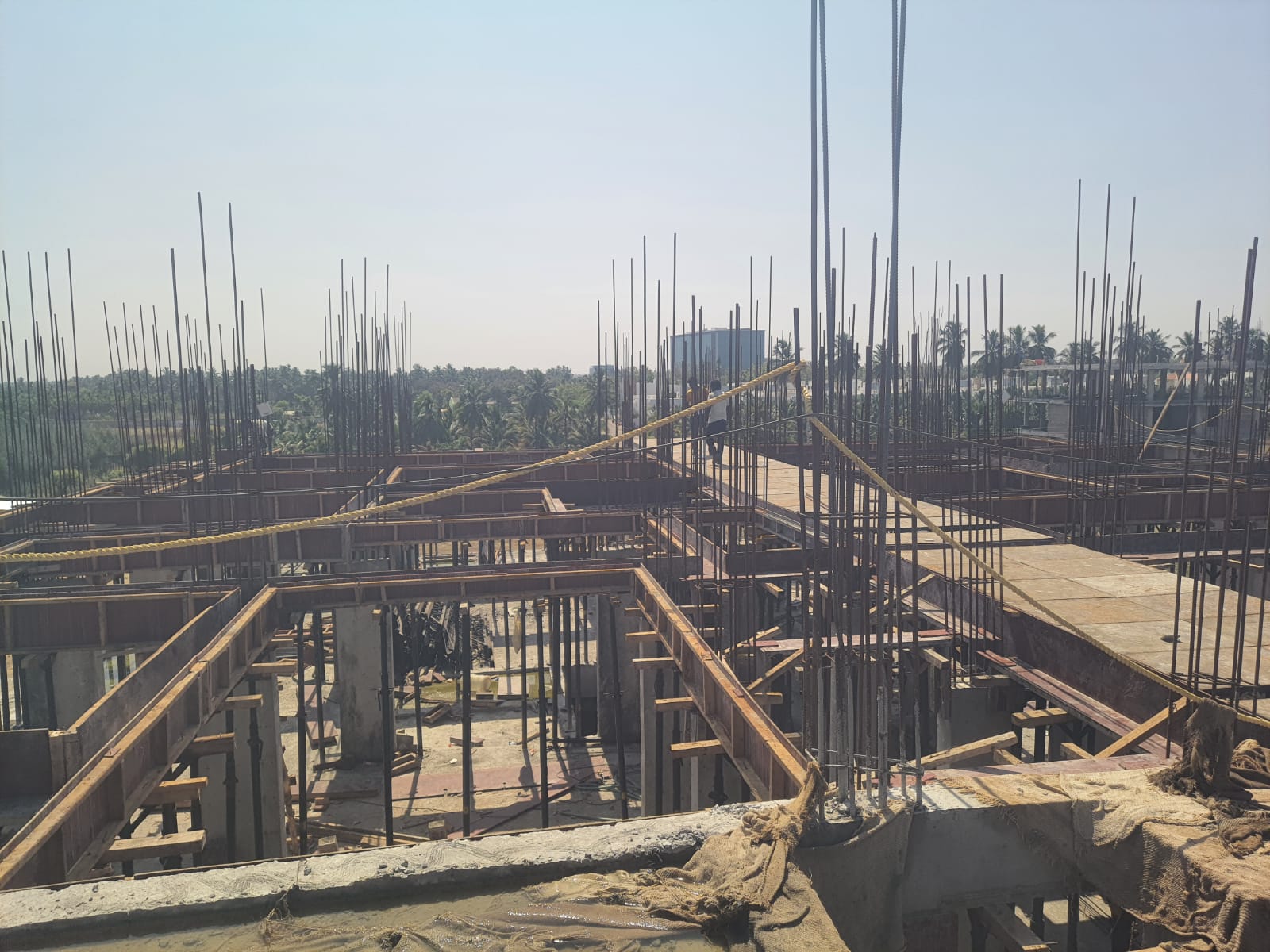

Update: Stilt Floor roof slab - Concrete work completed.
Project Update
Update: One part of first floor roof shuttering work has been started
Project Update
Update: One part of stilt floor roof slab- curing work is in progress
Project Update

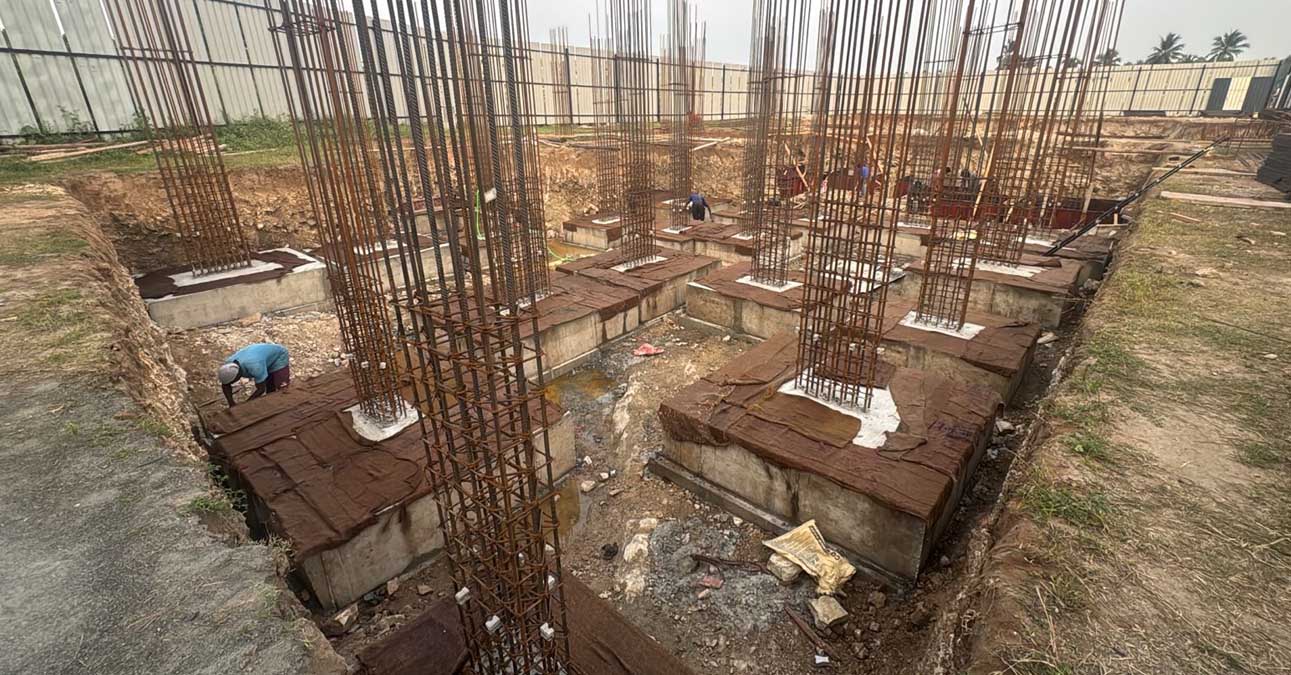

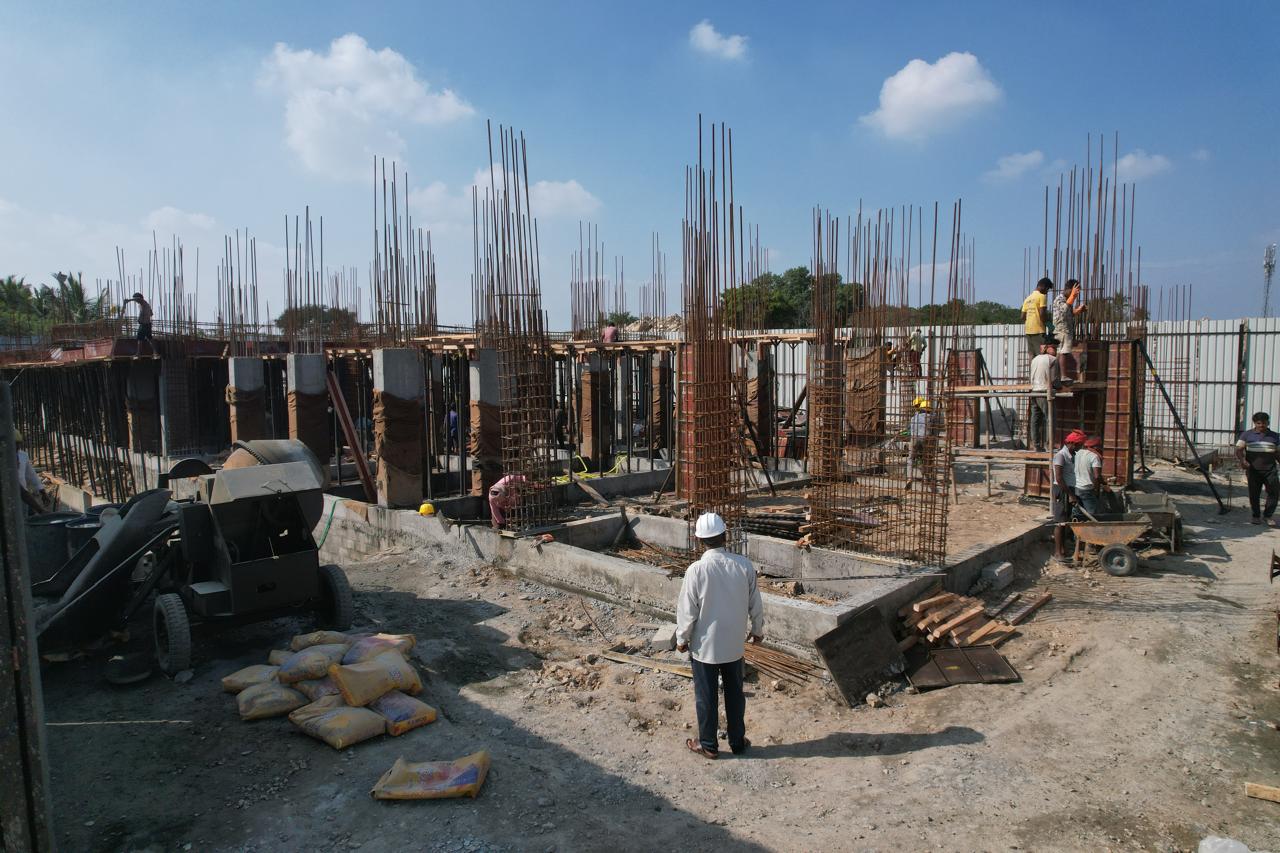

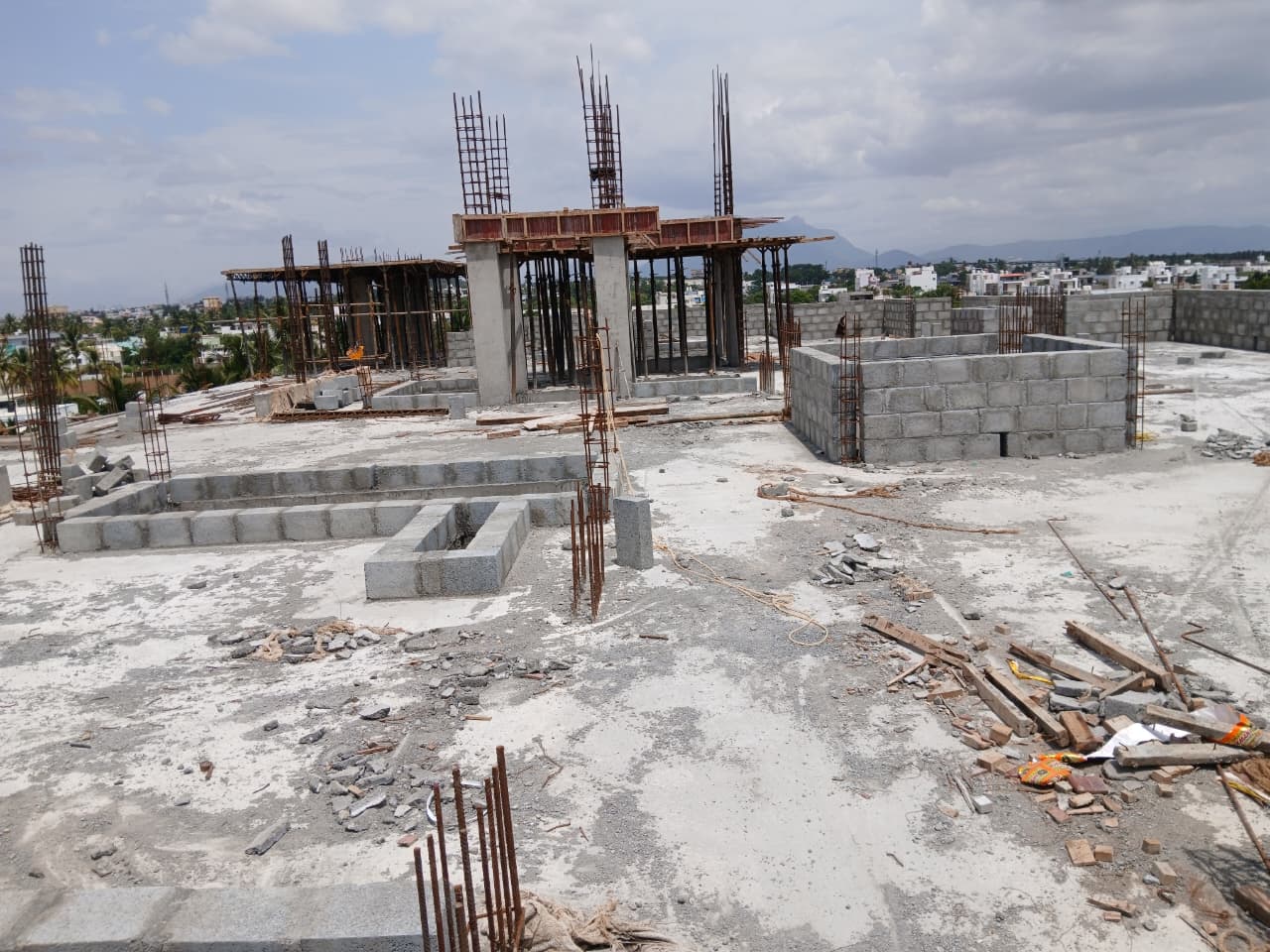

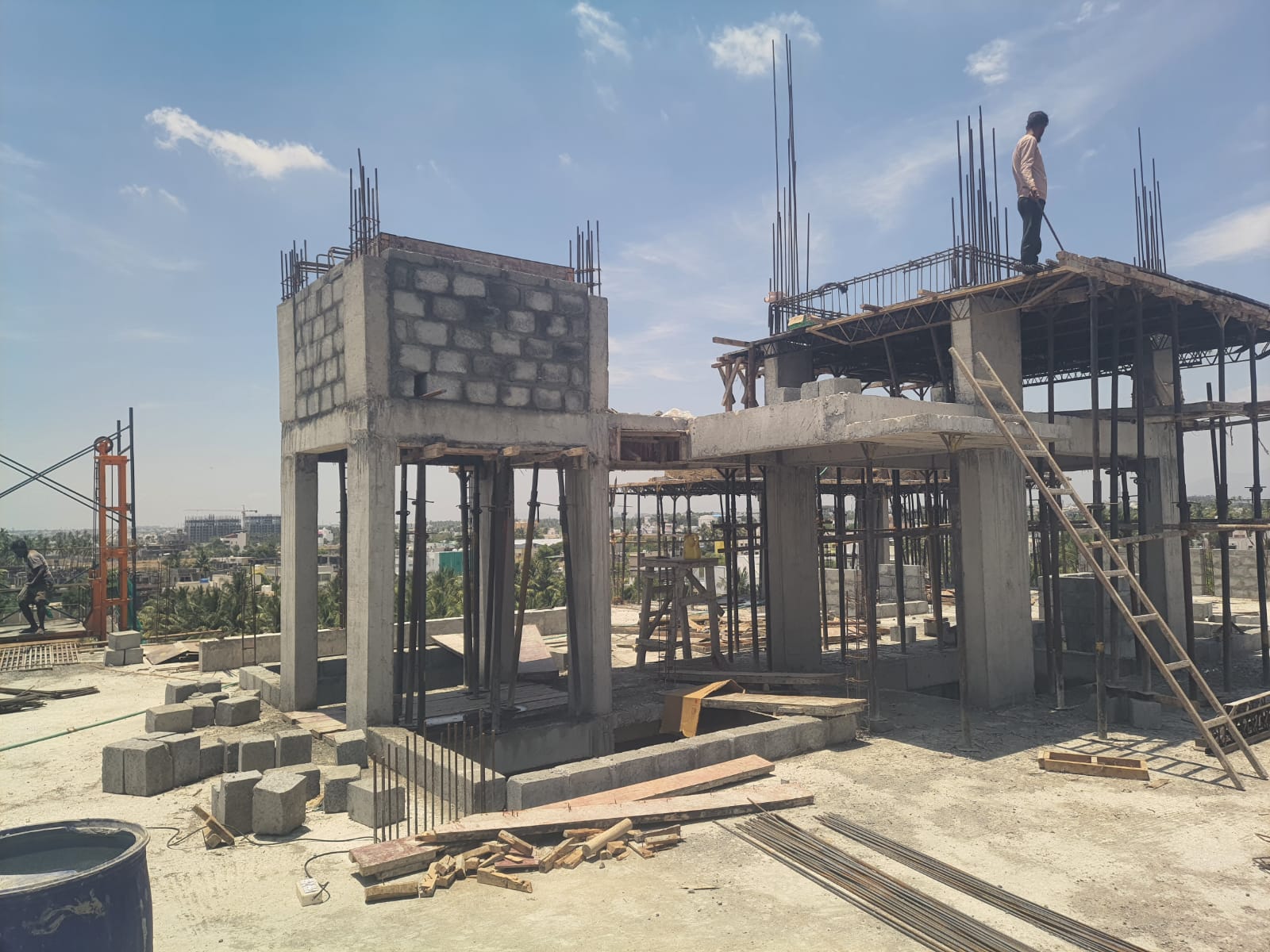

Update: First floor - Column work completed
Project Update

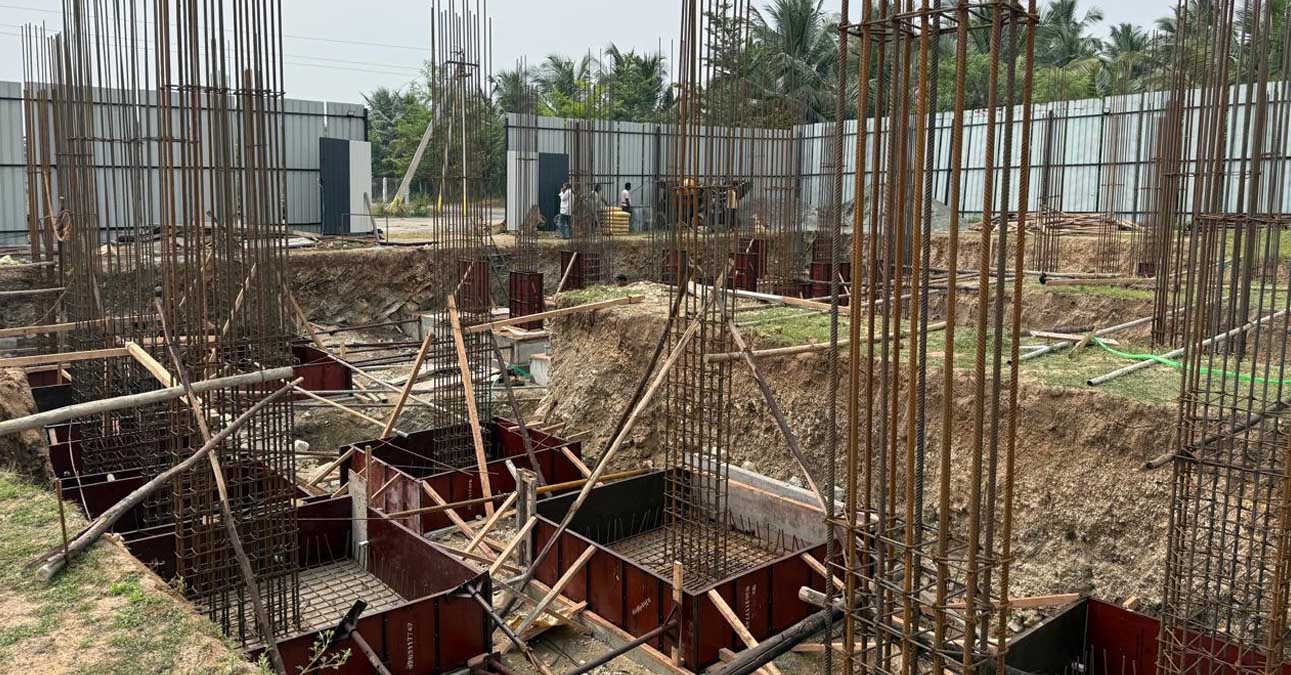

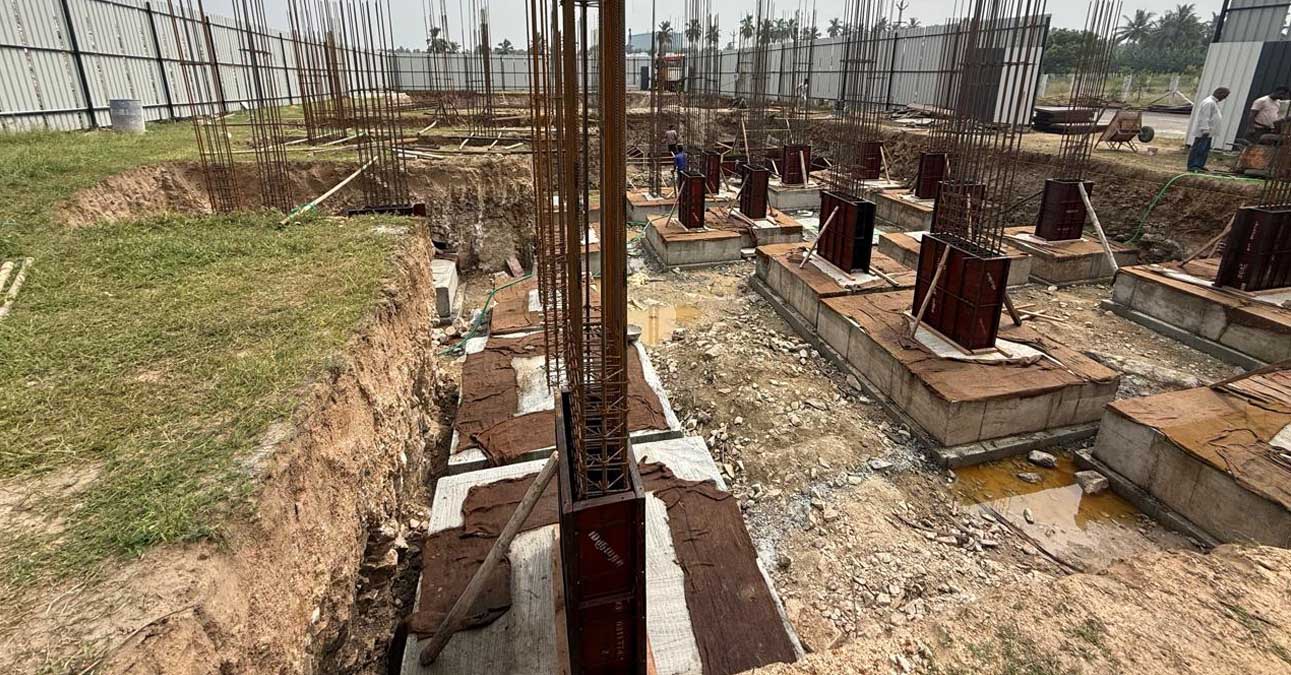

Update: One part of Stilt floor Roof Slab is ready for concrete
Project Update
Update: One part of Stilt floor Roof Slab is ready for concrete
Project Update
Update: One part of Stilt floor Roof Slab is ready for concrete
Project Update

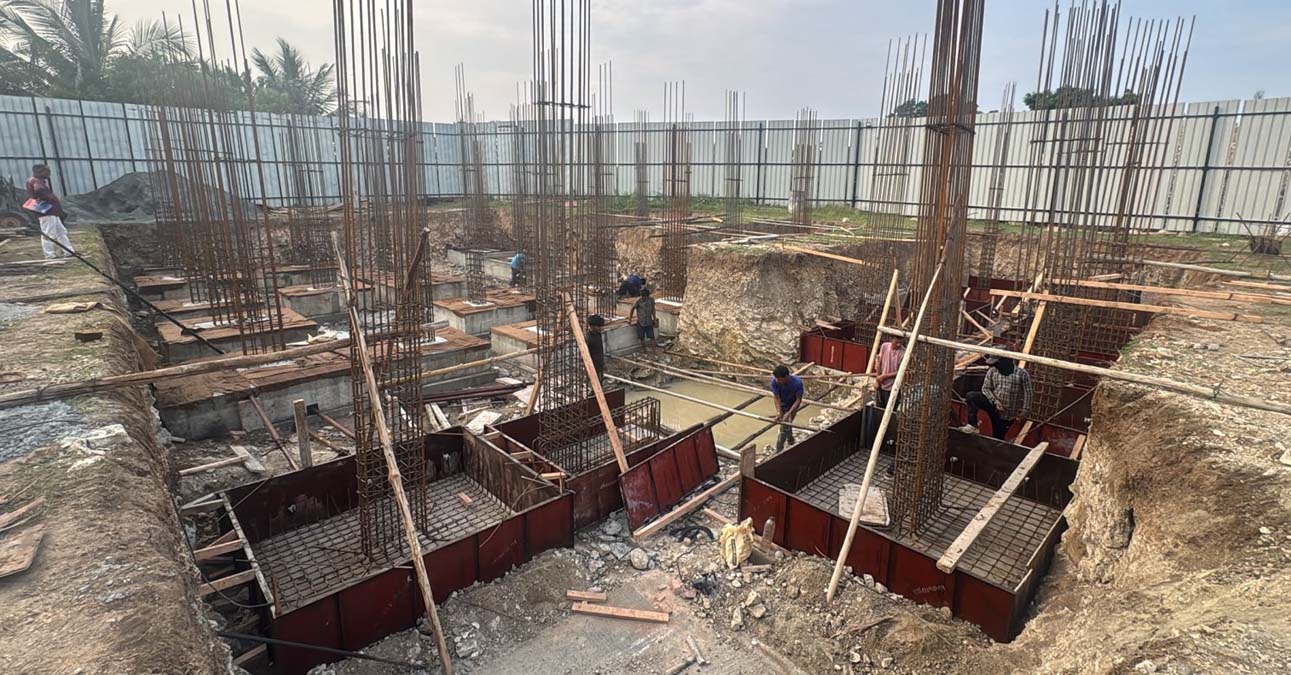

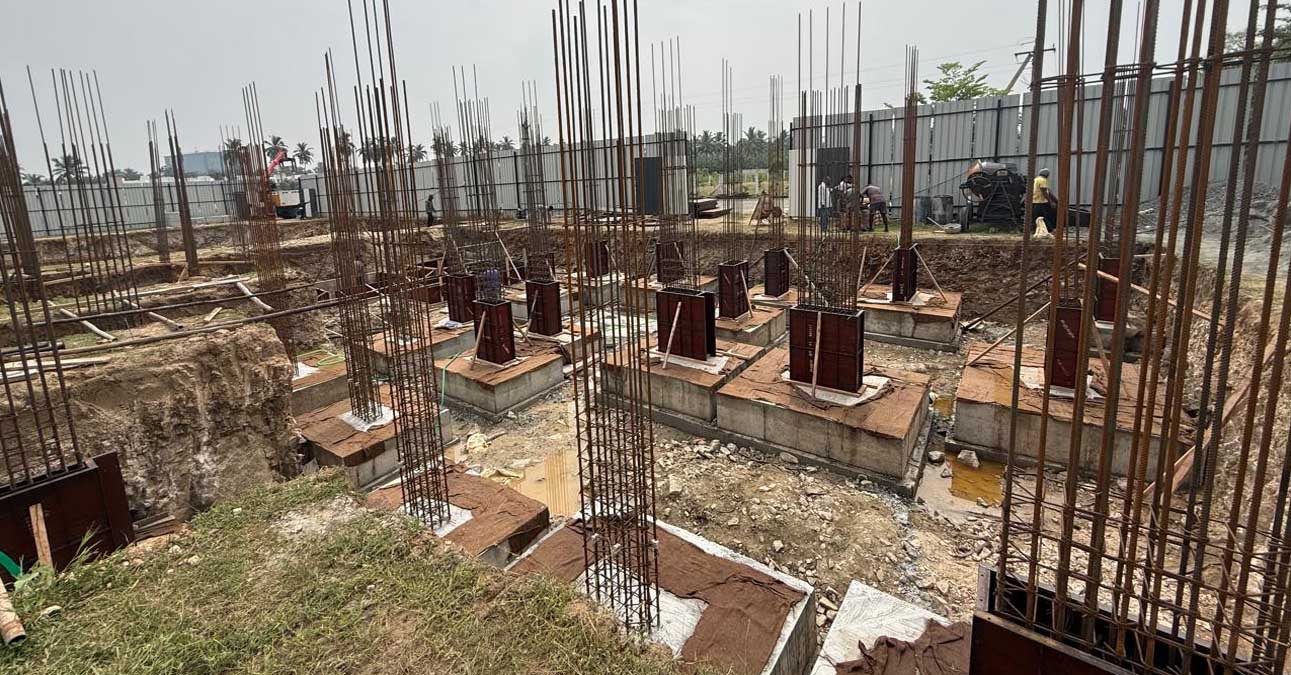

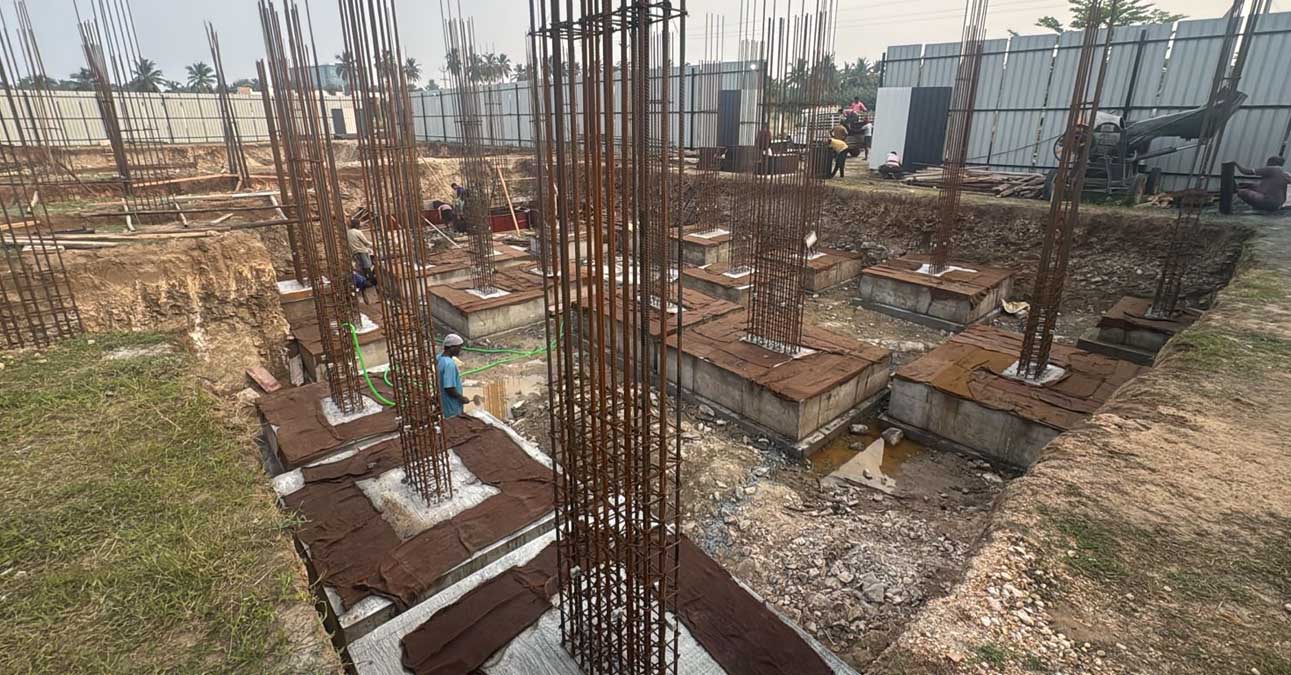

Update: A part of Stilt floor- Column work is done
Project Update

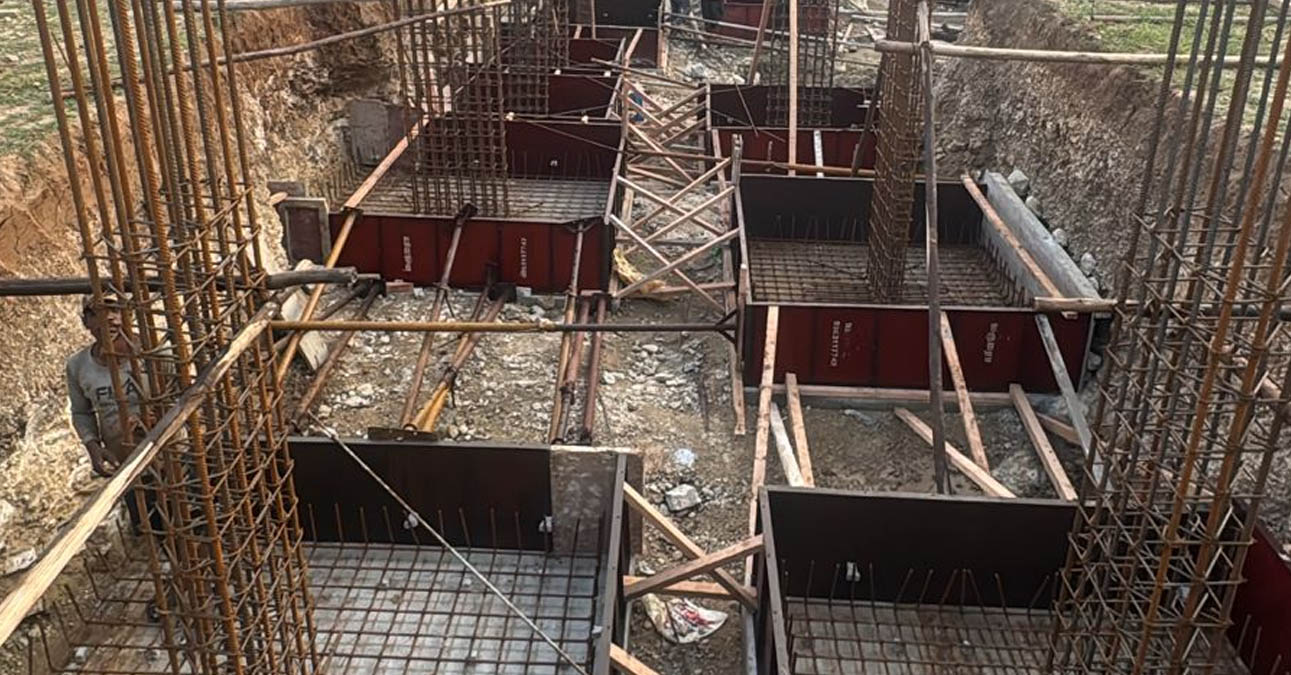

Basement Construction
Project Update
Basement Construction
Project Update
Basement Construction
Project Update
Basement Construction
Project Update
Basement Construction
